Right first time (RFT) is the manufacturing principle that every unit must be produced correctly on the first attempt, without rework, repair, or inspection escapes, as a standard operational expectation rather than an aspirational target. Where first pass yield is a measurement metric that quantifies how often this standard is achieved, right first time is the organizational philosophy and operational culture that makes achieving it the non-negotiable baseline. Research across manufacturing sectors shows that companies spend between 15 and 40 percent of their turnover on the consequences of poor quality, including rework labor, material waste, inspection overhead, and customer failures. RFT implementation addresses this cost not by managing rework more efficiently but by treating rework as an organizational failure that the quality system, production processes, and workforce capability must be designed to prevent.
The distinction between RFT as a culture and FPY as a metric is operationally significant. An organization can measure FPY consistently and use it to track improvement while still treating rework as an acceptable and expected part of daily operations. An organization that has genuinely implemented RFT has eliminated the cultural and structural conditions that make rework acceptable, investing instead in the process design, standard work, error proofing, and operator capability that make correct first-time production the default rather than the exception.
Right First Time vs First Pass Yield: Understanding the Distinction
The relationship between RFT and FPY is one of culture to measurement rather than two competing metrics. Understanding the distinction prevents organizations from treating RFT implementation as a data collection project rather than as an operational transformation.
[First Pass Yield: Definition, Calculation, and Improvement] covers the FPY formula, rolled throughput yield, and measurement requirements in full. The relationship to RFT is as follows:
- FPY answers the question: what percentage of units did we produce correctly on the first attempt during this measurement period?
- RFT answers the question: have we designed the organization, the processes, and the workforce capability to make correct first-time production the standard rather than the outcome we hope for?
An organization can have high FPY in a given period through a combination of process discipline and favorable conditions, then lose that performance when conditions change, because the underlying RFT culture and systems are not in place. An organization that has implemented RFT maintains high FPY consistently across shifts, operators, product variants, and operating conditions because the systems that enable correct first-time production are embedded in how the work is designed and executed.

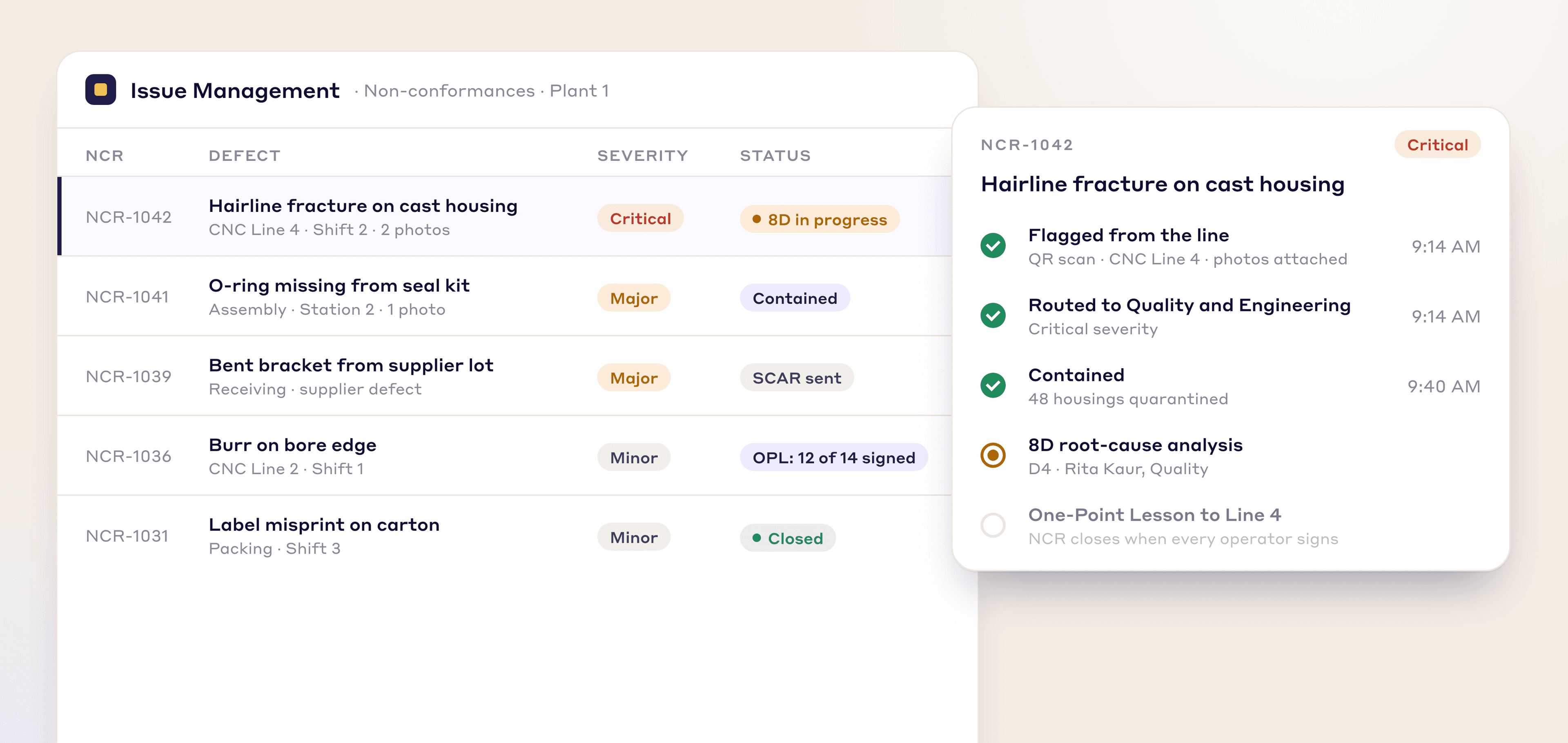

The practical test of whether an organization has RFT culture rather than just FPY tracking is the response to rework events. In an FPY-tracking organization, rework events are counted, entered into the metric, and reported. In an RFT organization, every rework event triggers a structured investigation into why the process did not produce conforming output the first time, with a countermeasure implemented before the next production run.
Key Insight: High FPY in a given period does not confirm RFT culture. RFT culture is confirmed by the organizational response to rework events, not by the metric value in any single period.
The Five Principles of Right First Time Manufacturing
RFT operates through five interconnected principles that together define the organizational conditions under which correct first-time production becomes the operational norm. Implementing any subset of these principles without the others produces improvement without the cultural and systemic foundation that sustains it.
Prevention Over Detection
The prevention principle establishes that the primary quality investment should be in designing processes and controls that prevent defects from being created, rather than in detecting them after creation. This principle connects directly to the jidoka foundation of [Quality at the Source: Building Quality Into the Production Process] and to the cost economics of the 1-10-100 rule.
In RFT implementation, the prevention principle means that every recurring defect type triggers a root cause investigation and a physical countermeasure before any additional inspection is added. Inspection added in response to a recurring defect treats the symptom. A poka-yoke device that makes the defect physically impossible to create or pass forward treats the cause.
Process Capability Before Production
The process capability principle establishes that a process must demonstrate it can produce conforming output consistently before it is approved for full-scale production. Running a process that is not statistically capable of meeting specifications and relying on inspection to remove non-conforming output is not quality management. It is defect screening at full production cost.
Process capability studies, covering Cp and Cpk analysis before production begins, confirm that the process variation is sufficiently contained within the specification limits to produce conforming output reliably. A process with a Cpk below 1.33 does not meet the RFT standard regardless of how good a given production run appears, because the process variation makes non-conforming output statistically inevitable over time.
Standard Work as the Quality Foundation
The standard work principle establishes that correct first-time production requires a defined, documented, and consistently followed best method for every production operation. Without standard work, each operator develops their own method, and quality performance varies with operator experience, shift, and concentration rather than reflecting a designed and verified process.
Standard work in the RFT context specifies not only the sequence and timing of production operations but also the in-process quality checks embedded in the work sequence, the acceptance criteria for each check, and the abnormality response protocol when a check fails. A standard work document that covers production steps without embedded quality checks is incomplete for RFT purposes.
Operator Capability and Responsibility
The operator capability principle establishes that right first time cannot be achieved by process design alone without operators who understand the quality standards for their work, can perform the required in-process checks, and have the authority and responsibility to stop production when an abnormality is detected.
GlaxoSmithKline's implementation of RFT principles across tablet production lines reduced batch rejection rates from 5.2 percent to 0.8 percent within eight months. Their approach combined rigorous process validation with operator capability development, ensuring that every operator understood the quality standards for their operation and the inspection criteria that defined conforming output.
Continuous Improvement of the Quality System
The continuous improvement principle establishes that RFT is not a fixed standard achieved once but an ongoing discipline of improving the quality system based on what defects actually occur, where they occur, and what process conditions generated them. Every defect is data. Every rework event is an improvement opportunity. Organizations that investigate rework events systematically and implement verified countermeasures continuously raise their RFT performance.
Key Insight: The five RFT principles are interdependent. Prevention without process capability produces countermeasures on unreliable processes. Process capability without standard work produces capable processes executed inconsistently.
The RFT Calculation and How to Use It
The right first time calculation uses the same formula as first pass yield at the finished product level:
RFT = (Flawless finished units / Total units produced) x 100
The distinction in how RFT is typically applied versus FPY is scope. FPY is commonly measured at individual process steps to identify where in the production sequence quality problems occur. RFT is commonly measured at the finished product level to provide an overall quality performance indicator that reflects the cumulative effect of all process steps.
Measuring RFT at the finished product level alongside rolled throughput yield at the process step level gives production management two complementary views:
- RFT at finished goods: what customers and the business experience as the quality outcome
- RTY at process step level: where in the production sequence the quality failures that drive RFT down are originating
The gap between a high RFT figure and the underlying RTY calculation reveals how much rework is being absorbed in production to achieve the finished goods result. A plant with 96 percent finished goods RFT and an RTY of 78 percent is absorbing 18 percentage points of quality failure through rework before units reach finished goods inspection.
Key Insight: RFT at finished goods and RTY at process step level are complementary views. RFT shows the output quality. RTY reveals the hidden rework cost required to achieve it.
Implementation Framework: Building Right First Time Into Operations
RFT implementation is not a project with a completion date. It is a systematic transformation of how quality is designed, managed, and improved across the production system. The implementation framework follows five stages that build RFT capability progressively rather than attempting to install the full system at once.
Stage 1: Establish baseline measurement. Measure current RFT at the finished goods level and calculate RTY at each major process step. The baseline identifies where quality failures originate and quantifies the rework cost the production system is currently absorbing. Without this baseline, RFT improvement cannot be measured and improvement resources cannot be prioritized.
Stage 2: Implement standard work with embedded quality checks. For the three to five process steps with the lowest individual FPY, update or create standard work that specifies in-process quality checks, acceptance criteria, measurement methods, and abnormality response protocols. Standard work without embedded quality specification is not RFT-ready. [Non-Conformance Reports: Managing Quality Deviations in Manufacturing] provides the deviation documentation structure that captures rework events at the point where they occur, creating the data trail that drives Stage 3.
Stage 3: Investigate and eliminate the highest-frequency rework causes. For each process step identified in Stage 1, conduct structured root cause analysis of the highest-frequency rework causes. [FMEA in Manufacturing: Failure Mode and Effects Analysis Complete Guide] identifies the failure modes with the highest risk priority numbers, directing prevention investment toward the causes most likely to produce rework. Countermeasures that eliminate root causes are implemented and verified before the investigation closes.
Stage 4: Deploy error proofing at high-frequency rework origins. After root cause investigation confirms the process condition generating rework, error-proofing devices are designed and installed to make the defect impossible to create or impossible to pass forward undetected. [Poka-Yoke: Error Proofing Methods in Manufacturing] covers device selection and design criteria for the three poka-yoke types. Error proofing converts the prevention principle from an aspiration into a physical production system characteristic.
Stage 5: Sustain through audit and continuous improvement. RFT gains erode without structured sustainment. Layered process audits verify that standard work is being followed, that in-process quality checks are being performed, and that abnormality response protocols are being activated when checks fail. [CAPA Systems in Manufacturing: Corrective and Preventive Action Explained] manages the corrective and preventive action pipeline that converts new rework events into verified improvements, keeping the RFT improvement cycle active.
Key Insight: RFT implementation is a staged operational transformation, not a quality program with a launch date. Each stage builds the capability that the next stage depends on.
Common RFT Implementation Failures
Three failure modes account for the majority of RFT programs that generate activity without sustained performance improvement.
Treating RFT as a metric target rather than a cultural standard. Organizations that set an RFT target of 95 percent and manage to the number without changing the structural conditions that produce rework will find that performance fluctuates around the target without establishing the cultural foundation that makes the target sustainable. RFT culture is established by the organizational response to rework events, not by the metric value.
Implementing standard work without quality checks embedded. Standard work that specifies production steps without specifying quality checks, acceptance criteria, and abnormality response protocols is production documentation, not RFT infrastructure. The quality specification embedded in the standard work sequence is the mechanism that gives operators the specific criteria they need to make conformance decisions at the point of production.
Skipping process capability confirmation before production begins. Deploying error proofing and standard work on a process whose inherent variation makes conforming output statistically unreliable produces RFT infrastructure on an incapable process. The infrastructure cannot compensate for process variation that exceeds specification limits. Process capability confirmation is the prerequisite for every other RFT implementation element.
Key Insight: RFT programs fail when they treat metric management as the intervention. The intervention is process capability, standard work with quality specifications, and structured response to every rework event.
Within the Lean System
Connection to Lean Principles
Right first time operationalizes the lean principle of building quality in at the production level, extending the jidoka pillar from a machine-level detection mechanism to an organization-wide quality culture. The [5 Core Principles of Lean Manufacturing] establish the pursuit of perfection as the fifth lean principle. RFT is the specific articulation of what pursuing perfection means for production quality: not inspecting better, not reworking more efficiently, but designing the production system so that conforming output is the designed result rather than the inspected outcome.
Connection to Lean Tools
[Quality at the Source: Building Quality Into the Production Process] provides the operational foundation that RFT implementation builds on, covering successive checking, self-checks, and poka-yoke as the in-process quality control mechanisms. [Poka-Yoke: Error Proofing Methods in Manufacturing] implements the prevention principle at the device level, converting the RFT standard into a physical production system characteristic that does not depend on operator attention or inspection discipline. Standard work is the vehicle through which quality specifications, acceptance criteria, and abnormality response protocols are embedded in every production operation.
Connection to Continuous Improvement
RFT and continuous improvement are mutually dependent. RFT provides the organizational standard that makes every rework event an improvement trigger rather than an operational routine. Continuous improvement provides the structured methodology through which each identified rework cause is investigated, eliminated, and verified. The [PDCA Cycle: The Foundation of Continuous Improvement] structures each RFT improvement cycle from rework event identification through countermeasure implementation to verified performance remeasurement, ensuring that the RFT standard advances rather than plateaus.
Frequently Asked Questions
What is right first time in manufacturing? Right first time (RFT) is the manufacturing principle that every unit must be produced correctly on the first attempt without rework, repair, or inspection escapes as a standard operational expectation. Where first pass yield is the metric that measures how often this standard is achieved, RFT is the organizational culture and production system design that makes achieving it the designed default rather than the hoped-for outcome.
How is Right First Time different from First Pass Yield? First pass yield is a measurement metric that quantifies the percentage of units produced correctly on the first attempt during a measurement period. Right first time is the organizational philosophy and operational culture that defines correct first-time production as the non-negotiable standard. High FPY in a given period does not confirm RFT culture. RFT culture is confirmed by whether every rework event triggers structured root cause investigation and countermeasure implementation, or whether rework is counted and accepted as normal.
How is right first time calculated? RFT is calculated by dividing the number of flawless finished units by total units produced and multiplying by 100. RFT is typically measured at the finished goods level to provide an overall quality performance indicator. It is most informative when used alongside rolled throughput yield at the process step level, which reveals where in the production sequence the quality failures driving RFT down are originating and how much rework the system absorbs to achieve the finished goods result.
What are the five principles of Right First Time manufacturing? The five RFT principles are prevention over detection (designing out defects rather than inspecting for them), process capability before production (confirming statistical capability before full-scale operation), standard work as the quality foundation (embedding quality checks and acceptance criteria in every operation), operator capability and responsibility (training and authorizing operators to maintain the standard), and continuous improvement of the quality system (treating every rework event as an improvement trigger rather than a routine cost).
Why do Right First Time programs fail? RFT programs most commonly fail for three reasons: treating RFT as a metric target rather than a cultural standard and managing the number without changing structural conditions, implementing standard work that specifies production steps without embedding quality checks and acceptance criteria, and deploying error proofing and standard work on processes whose inherent variation makes conforming output statistically unreliable. All three failures produce RFT activity without the sustained performance improvement that genuine RFT culture delivers.
