Kaizen event in a box

Kaizen event in a box is the complete kit for running a five-day kaizen event. The 24-page facilitator guide covers picking the right problem, the charter, the team, the pre-work from three weeks out, each day minute by minute from Monday's current state to Friday's report-out, the ten conversations that derail events, and the 30-60-90 day sustain plan. Two editable PowerPoint decks run the Monday kick-off and the Friday report-out. The Excel workbook holds the charter, roster, daily board, idea matrix with live scoring, action tracker and before-and-after metrics. The A3 event board fits on one sheet. The method follows the Lean Enterprise Institute's Lean Lexicon and the US Environmental Protection Agency's Lean in Government Starter Kit, and the kit links to this site's single-form templates (charter, preparation checklist, tracker) instead of repeating them.

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

Cover of the kaizen event in a box facilitator guideA navy page titled Kaizen event in a box, one paragraph on what a kaizen event is, and five cards naming the guide, the kick-off deck, the report-out deck, the workbook and the A3 board.
Pick the right problem: six questionsCharter and boundariesRoles and team sizePre-work from three weeks outFive days, minute by minuteTen conversations that go wrongReport-out in 45 minutes30-60-90 sustain planKick-off and report-out decksWorkbook with live scoringA3 board

What is in the box

Five files that run the week end to end

The guide is for the facilitator. The decks are for the team and the sponsor. The workbook is the scribe's one open laptop. The board is on the wall. Each picture below is a page or slide of the actual file.

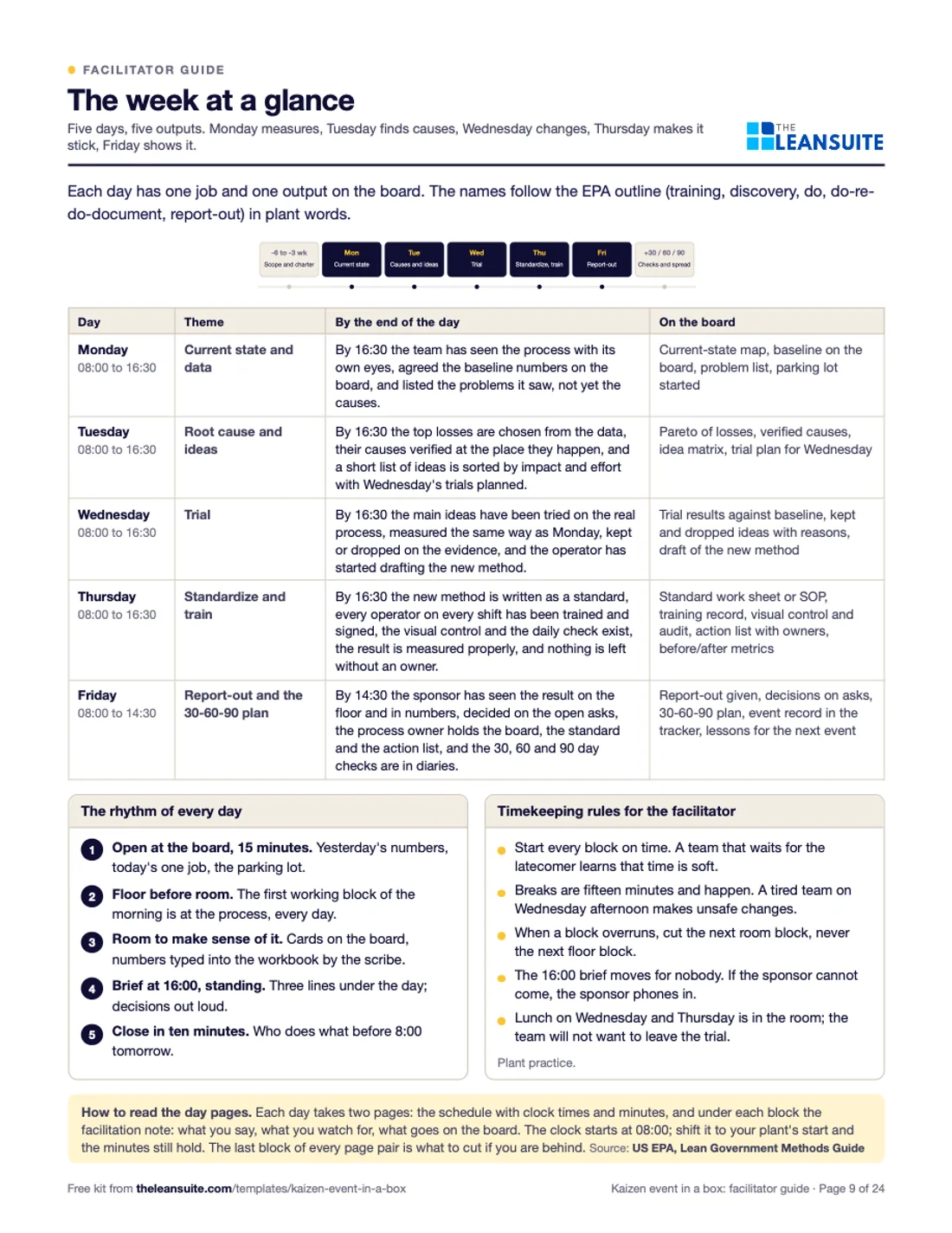

  • The week at a glance

    Facilitator guide (PDF)

    24 pages, Letter (prints on A4): problem choice, charter, team, pre-work, five days minute by minute, conversations that go wrong, report-out, sustain plan, sources.

    923 KB · 24 pages

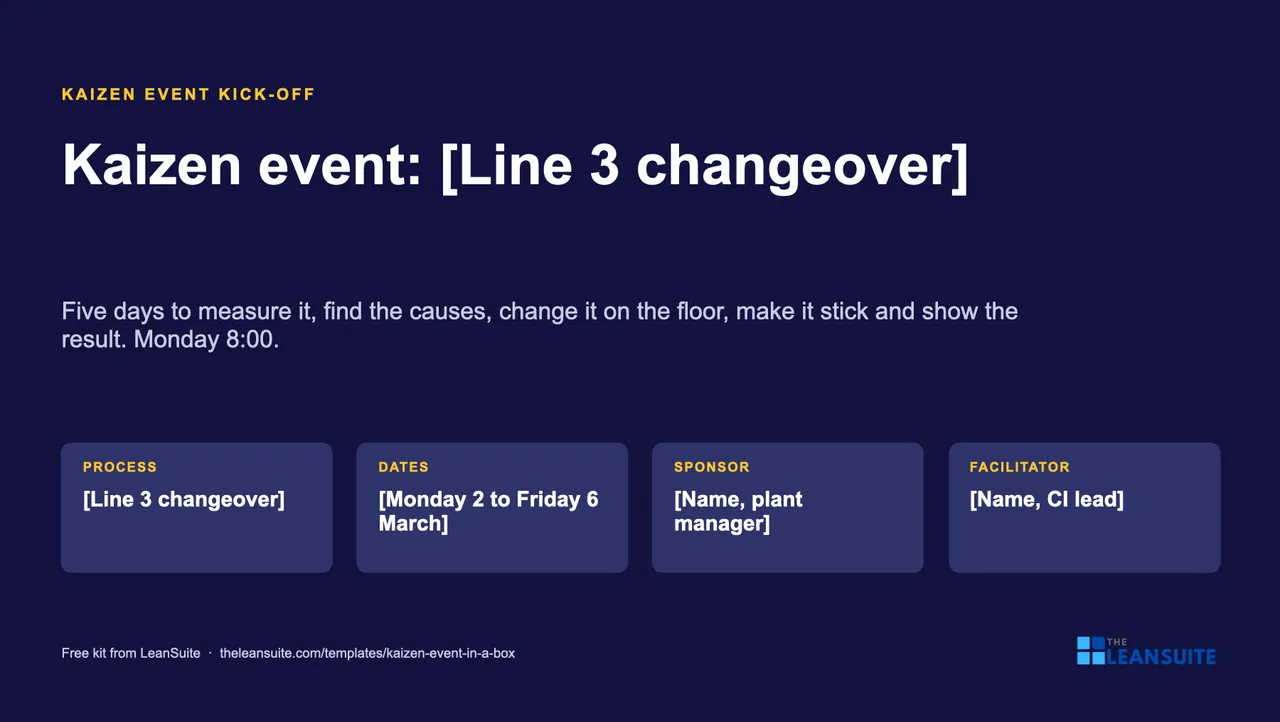

  • Kick-off deck: cover (slide 1 of 12)

    Kick-off deck (PowerPoint)

    12 editable slides for Monday 8:00 with speaker notes: why we are here, charter, metrics, boundaries, team, ground rules, the week, today, the board, Friday, logistics.

    721 KB · 12 slides

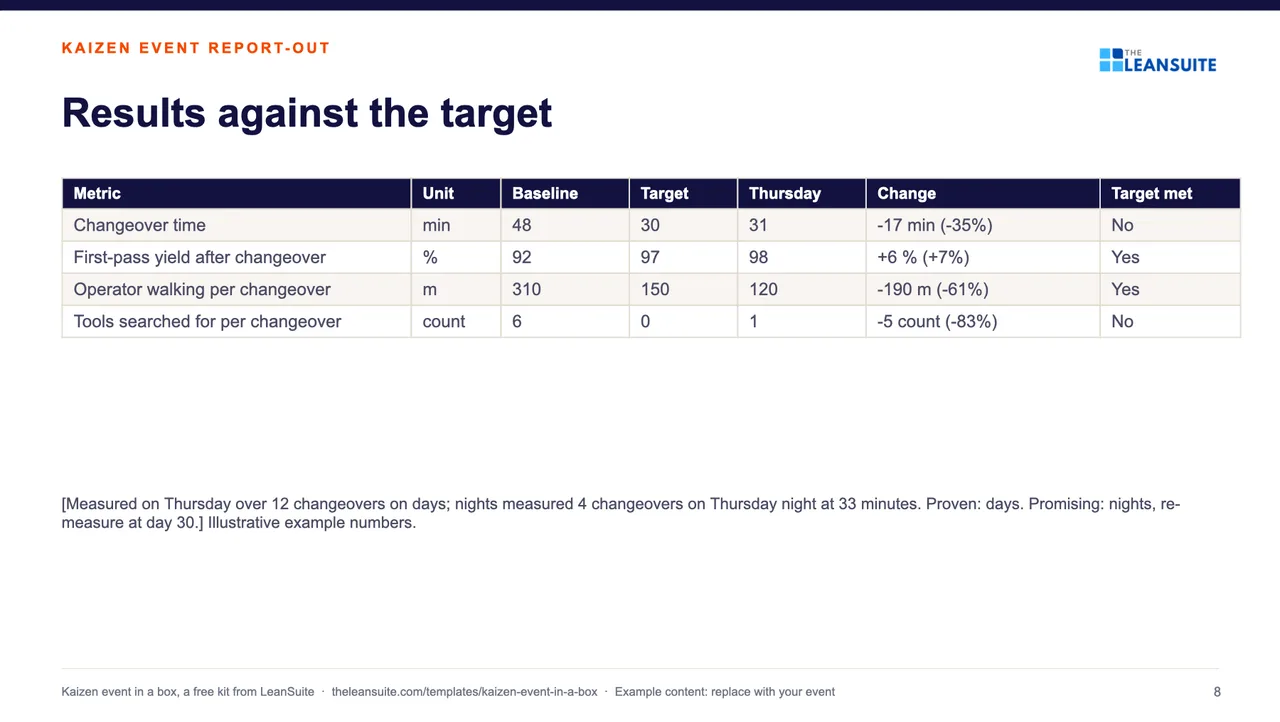

  • Report-out deck: results against the target (slide 8 of 12)

    Report-out deck (PowerPoint)

    12 editable slides for Friday 11:00 in the order of the board: problem, team, findings, causes, trials, changes, results, standard, open actions, 30-60-90, asks.

    730 KB · 12 slides

  • Workbook: Read me sheet

    Event workbook (Excel)

    Charter with date checks, roster with size check, daily board, 40-idea impact-effort matrix with score, quadrant and rank, 60-action tracker with late flags, before/after metrics with % change and gap closed, worked example.

    38 KB

  • The A3 event board

    A3 event board (PDF)

    One sheet, A3 landscape (prints at tabloid, or Letter and A4 with fit to page): nine zones in the order of the week.

    148 KB · 1 pages

The week, day by day

Monday measures, Tuesday finds causes, Wednesday changes, Thursday makes it stick, Friday shows it

Each day has one job and one output on the board. The guide gives every block with its clock time and a facilitation note; here are the longest blocks of each day. The clock starts at 08:00 and shifts with your plant's start.

  1. 6 to 3 weeks out

    Scope and charter

    Scoping meeting, charter signed at week three, baseline measured, team released, support booked.

  2. 108:00 to 16:30

    Monday

    Current state and data

    • 08:30Charter walk-through
    • 10:15Gemba walk one: observe in pairs
    • 12:30Build the current state on the board
    • 14:15Gemba walk two: verify the map

    On the board: Current-state map, baseline on the board, problem list, parking lot started

  3. 208:00 to 16:30

    Tuesday

    Root cause and ideas

    • 08:15Choose the losses to attack
    • 09:15Root cause at the gemba
    • 10:45Causes confirmed and assumptions listed
    • 12:30Idea generation

    On the board: Pareto of losses, verified causes, idea matrix, trial plan for Wednesday

  4. 308:00 to 16:30

    Wednesday

    Trial

    • 08:15Try it on the floor
    • 11:00Measure and compare
    • 12:30Second round
    • 14:45Draft the new method with the operator

    On the board: Trial results against baseline, kept and dropped ideas with reasons, draft of the new method

  5. 408:00 to 16:30

    Thursday

    Standardize and train

    • 08:15Write the standard properly
    • 10:00Train every operator on every shift
    • 12:30Visual control and the daily check
    • 13:30The action list

    On the board: Standard work sheet or SOP, training record, visual control and audit, action list with owners, before/after metrics

  6. 508:00 to 14:30

    Friday

    Report-out and the 30-60-90 plan

    • 08:30Build the report-out from the board
    • 09:45Dry run
    • 11:00Report-out
    • 12:00Lunch with the team

    On the board: Report-out given, decisions on asks, 30-60-90 plan, event record in the tracker, lessons for the next event

  7. Days 30, 60 and 90

    Checks and spread

    Weekly follow-up meeting, metric re-measured the same way, standard audited, actions closed, event closed in the tracker.

Day names follow the EPA Lean in Government Starter Kit's five-day outline (training, discovery, do, do-re-do-document, report-out) in plant words. The Lean Lexicon's kaizen event commonly lasts five days.

Before you book the room

Six questions that decide whether this problem fits a week

Most events fail in the choice of problem, weeks before day one. Score the candidate against these six questions. Five or six yes answers: run it. Three or fewer: fix the scope or pick another problem.

  • Is it one process with a clear start and end?

    A team can map and change one process in a week. "Packing, from last inspection to pallet wrapped" works. "Our delivery performance" does not.

  • Can you measure it before and after inside the week?

    The metric has to move in days, not months: minutes per changeover, metres walked, defects per shift, cases waiting. A monthly KPI cannot show a Wednesday trial worked.

  • Does the process run often enough to try changes on Wednesday?

    A line that runs every shift can be tested ten times before Friday. A process that happens twice a month cannot be trialled, only planned.

  • Is most of the fix within the team's reach?

    Moving a rack, re-sequencing steps, adding a visual, rewriting the standard: yes. A new machine, a software change, a change of rules: those sit outside the event's boundaries and go to the parking lot, as the EPA kit suggests for changes that need rulemaking.

  • Does it hurt the operators as well as the sponsor?

    If the people doing the work feel the pain every shift, they will bring the ideas. If only the P&L feels it, you will be pulling teeth all week.

  • Can the right people be released for the full five days?

    The EPA kit puts the sponsor's job as getting team members 2 to 5 days away from their regular duties. Half-day attendance is the most common reason a Wednesday trial never happens.

Who does what

The EPA kit puts a Lean event team at 8 to 10 members, with 15 as the largest size it recommends; beyond that the facilitator cannot manage the room. Most of the team should be people who do the work every day. Add one or two people from outside the area for fresh questions, and keep observers to a few at a time.

Sponsor
The manager who owns the result and the budget: usually the plant manager or value stream manager. Helps write the charter, approves the time and money, opens Monday, comes to the 16:00 brief every day or sits in the event, decides on the asks at the Friday report-out, and holds the team to the 30, 60 and 90 day checks. The EPA kit lists each of these as the sponsor's job.
Process owner
The supervisor or area leader who has to run the new method on Monday week. On the team all week. Owns the standard, the training record and the action list after Friday. Chairs the weekly follow-up meeting.
Team leader
A respected person from the area, or a CI lead. Logistics before and during the week: room, releases, data pack, supplies, meals, the daily brief, the report-out invitations. Becomes the implementation team leader afterwards (EPA's term) and runs the action list to closure.
Facilitator
Someone trained in the method and neutral about the answer. Can be in-house CI or from outside the plant. Runs the agenda and the tools, keeps the team at the gemba, protects the quiet voices, keeps scope inside the charter, calls the sponsor when a boundary is reached, and never owns an idea.
Team members
Operators and technicians from every shift that runs the process, plus the support people the problem needs: maintenance, quality, planning, engineering, finance for the numbers. Released for the whole week. Observe, measure, propose, try, write the standard, present on Friday. Everyone presents.
Support on call
Maintenance, IT, tooling, purchasing, safety. Named before the event with a phone number and a two-hour response promise for Wednesday and Thursday. The EPA kit has these people on call where they are not full members.

Team size and the sponsor, team leader and facilitator roles follow the EPA Starter Kit; the process owner and the on-call promise are plant practice.

Where the method comes from

Every method statement in the guide traces to one of these; where the guide gives plant practice instead, it says so on the page. Read on October 18, 2026.

What this kit does not claim

  • Typical savings, payback or percentage improvement figures for kaizen events. None of the primary sources read for this kit publishes a general number, so the kit gives none.
  • A claim that five days is the only right length. The EPA guides give three to five days for a kaizen event and one to two for a point kaizen; this kit is built for five and says where to cut.
  • Named customers, plants or events. The worked example is invented and labelled as such.

A kaizen event is five days in which a small team measures one process, finds the causes of its biggest loss, tries fixes on the floor, writes the new standard and trains it, then shows the result and the follow-up plan to the people who sponsored it. This kit is everything the facilitator needs to run that week: the guide, the two decks, the workbook and the board.

Download the kit

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.
