PPAP, the production part approval process, is how an automotive supplier shows its customer that it understands every requirement for a part and that its production process can make it to those requirements at the quoted rate. It is defined in the AIAG PPAP manual, which lists 18 elements, from the design records to the part submission warrant (PSW), and five submission levels that set what is sent to the customer and what is kept on file. This checklist lists the 18 elements with columns for whether your customer needs each one for this submission, submit or retain, owner, due date, status and document reference. It also has the submission level, the reason for submission, a readiness count, open issues, the production run the parts came from, the warrant and the customer's disposition. The Excel version flags elements that are late, have no owner or no due date, and works out the percentage ready and the days left to the submission date.

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

Want this run for you? See how it works

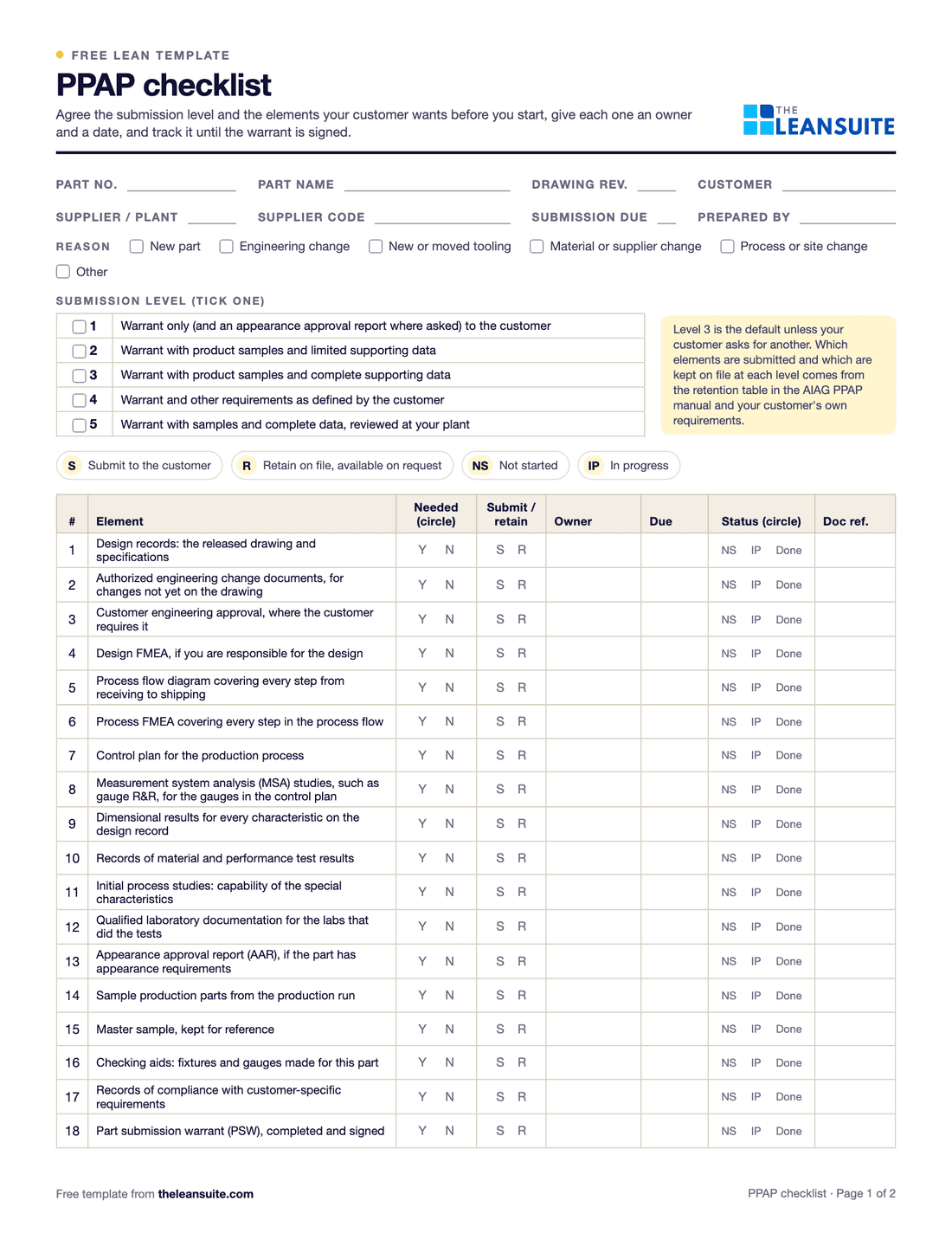

Page 1 of the PPAP checklistFields for part, customer and supplier, tick boxes for the reason and the five submission levels, and a table of the 18 PPAP elements with columns for needed, submit or retain, owner, due date, status and document reference.
The 18 PPAP elementsFive submission levelsSubmit or retainOwner, due date and statusReadiness countOpen issuesWarrant and customer disposition

When to use it

When to use a PPAP checklist

  • For a new part, before the first production shipment to the customer.
  • For an engineering change, new or moved tooling, a new material or supplier, or a process or site change, where your customer requires a new submission.
  • To plan the PPAP as a project, with an owner and a date for each element.
  • To check a supplier's submission to you against the same list.

How to fill it in

  1. 1

    Agree the level and the elements

    Level 3 is the default unless the customer asks for another. Confirm which elements they want submitted, which are kept on file, and any customer-specific requirements.
  2. 2

    Give each element an owner and a date

    Design records and change documents from engineering, the flow, PFMEA and control plan from the process team, MSA and dimensional results from quality, and so on.
  3. 3

    Run production parts

    The parts for the submission come from a significant production run, on production tooling, gauges, process and people, at the production rate.
  4. 4

    Measure and test

    Dimensional results for every characteristic on the design record, material and performance tests, initial process studies for the special characteristics and MSA on the gauges.
  5. 5

    Close the open issues

    Anything that stops a full approval, such as a capability below target or a missing record, goes on the open issues list with an action.
  6. 6

    Sign the warrant and submit

    Complete and sign the PSW, send what the level asks for, and record the customer's disposition: approved, interim approval or rejected.

What's on the checklist

The 18 elements on the PPAP checklist

Numbered as in the AIAG PPAP manual. On the sheet each element has columns for whether your customer needs it, submit or retain, owner, due date, status and the document reference.

The 18 PPAP elements

Numbered as in the AIAG PPAP manual

  1. 1Design records: the released drawing and specifications
  2. 2Authorized engineering change documents, for changes not yet on the drawing
  3. 3Customer engineering approval, where the customer requires it
  4. 4Design FMEA, if you are responsible for the design
  5. 5Process flow diagram covering every step from receiving to shipping
  6. 6Process FMEA covering every step in the process flow
  7. 7Control plan for the production process
  8. 8Measurement system analysis (MSA) studies, such as gauge R&R, for the gauges in the control plan
  9. 9Dimensional results for every characteristic on the design record
  10. 10Records of material and performance test results
  11. 11Initial process studies: capability of the special characteristics
  12. 12Qualified laboratory documentation for the labs that did the tests
  13. 13Appearance approval report (AAR), if the part has appearance requirements
  14. 14Sample production parts from the production run
  15. 15Master sample, kept for reference
  16. 16Checking aids: fixtures and gauges made for this part
  17. 17Records of compliance with customer-specific requirements
  18. 18Part submission warrant (PSW), completed and signed

A filled-in example

Illustrative, not a benchmark

An example: tracking a level 3 submission for a new stamped bracket (illustrative).

The example submission, three weeks before the due date

  • Done: 9 elements
  • In progress: 5 elements
  • Not started: 2 elements
  • Not required: 2 elements

Of the 18 PPAP elements, 2 were not required by this customer. Of the 16 required, 9 were done, 5 in progress and 2 not started three weeks before the due date.

16 of the 18 elements were required. Seeing 7 still open with three weeks to go is what put the late checking fixture on the table early.
  • Customer needs 16 of the 18 elements: no design FMEA (the customer owns the design) and no appearance approval report.
  • Three weeks before the due date: 9 done, 5 in progress, 2 not started; the checking fixture was late from the toolmaker.
  • Open issue: one hole position had a capability below the customer's target in the initial study.
  • Action: the die was adjusted and the study repeated on a new run before the warrant was signed.

All 16 elements were done two days before the due date and the customer gave full approval. Without the checklist, the late fixture would have been found in the last week.

Common mistakes

  • Parts from a trial run

    PPAP parts must come from a significant production run on production tooling and process, not hand-picked parts from a prototype run.

  • Not agreeing the level first

    Assuming level 3 when the customer wants something else, or missing a customer-specific requirement, means a rejected submission.

  • Documents that disagree

    The process flow, PFMEA and control plan must list the same steps. Reviewers look for the mismatch.

  • Starting in the last month

    Gauges, fixtures, lab tests and capability studies take time. Plan the PPAP from the tooling kick-off.

From this worksheet to a running system

For the parts this PPAP approves, LeanSuite runs receiving inspections on a tablet and scores each supplier from the results.

  • Part-specific inspection checklists on a tablet at the dock, with required photos as proof on arrival.
  • A flagged defect quarantines the batch and sends a SCAR with photos to Quality and Procurement.
  • Every inspection and SCAR feeds a live supplier scorecard with PPM defect rates by vendor.
LeanSuite Tier 3 plant daily review board with safety hazards by status, quality issues by line and line-stopping breakdowns per week

Download the template

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

Run this template in LeanSuite

LeanSuite runs part-specific receiving inspections on a tablet with required photos, routes each defect as a SCAR to Quality and Procurement, and builds a supplier scorecard with defect PPM by vendor.

See it in a 45-minute demo

FAQ

PPAP checklist: common questions

  1. Design records, authorized engineering change documents, customer engineering approval, design FMEA, process flow diagram, process FMEA, control plan, measurement system analysis, dimensional results, material and performance test results, initial process studies, qualified laboratory documentation, appearance approval report, sample production parts, master sample, checking aids, customer-specific requirements and the part submission warrant.

  2. Level 1 is the warrant only. Level 2 adds product samples and limited supporting data. Level 3 adds complete supporting data and is the default. Level 4 is the warrant and whatever else the customer defines. Level 5 is the warrant with samples and complete data reviewed at the supplier's plant.

  3. The summary document the supplier signs to declare that the parts meet every requirement and were made on the production process. It is the last of the 18 elements and is submitted at every level.

  4. For a new part and, typically, for changes such as an engineering change, new or moved tooling, a new material or sub-supplier, or a change of process or site. Your customer's requirements say which changes need a submission and which only need notice.

  5. The capability of the special characteristics, usually as Ppk from an initial run. The acceptance levels come from the AIAG PPAP manual and your customer; a common target for a new process is 1.67.

More free templates

All templates
Browse all 278 templates

Can't find the template you need?

Tell us what you're looking for. We'll make it and send it to your inbox, free.

A shift handover sheet, a red tag log, a changeover checklist for one machine: if your team uses it on the floor, ask.

By sending this form you agree to our Terms of Service and Privacy Policy.

Pass it on

We want LeanSuite to be the best place on the internet for lean help. If this was useful, send it to someone on your team or in your network who needs it.
