Cost deployment pillar 90-day model area plan

A cost deployment model area plan is a 90-day plan for proving, in one area, that every loss can be found, costed and turned into ranked projects with savings finance agrees, before the same loss map is used to steer every pillar. The team collects the costs and loss data, maps each loss to the process step where it happens, separates causal from resultant losses, puts a cost on each loss with rates agreed with finance, ranks the losses by cost, matches each top loss to a method and a pillar owner, estimates the savings, launches the projects and follows the savings up. This template has the 13-week plan as a Gantt chart in three phases with the owner, deliverable and done-when of each activity, a scoring table to choose the model area, the team, a KPI board, the day-90 gate, and the expansion plan for months 4 to 12 in three waves, with a worked example.

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

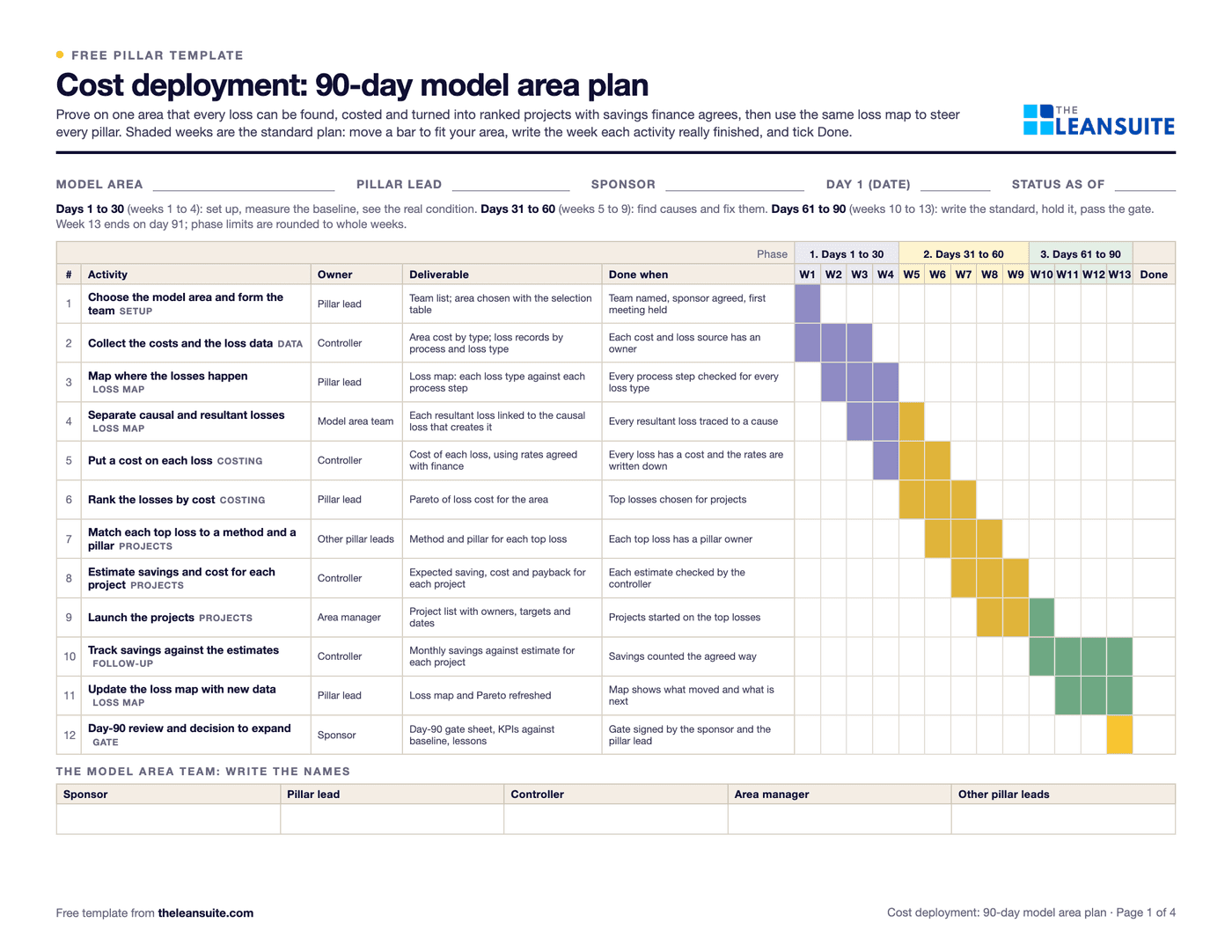

Page 1 of the cost deployment 90-day model area plan: a 13-week Gantt chart in three phases with the owner, deliverable and done-when of each activity, from collecting the costs and loss data to the day-90 gate.
13-week Gantt planLoss map to savingsModel area scoringTeam rolesKPI boardDay-90 gateExpansion wavesWorked example

When to use it

When to use a cost deployment 90-day plan

  • When improvement projects are chosen by opinion and nobody can say which losses cost the most.
  • When the pillars compete for the same people and need one ranked list of losses to agree where to work.
  • When finance does not recognize the savings that improvement teams report.
  • When leaders want a plan they can review every week: who does what, by when, and what done looks like.

How to fill it in

  1. 1

    Choose the model area

    Score up to three candidate areas (five in Excel) on loss data, visibility, team willingness and repeatability, from 1 to 3. Here loss data means a large share of conversion cost with loss records available. Pick the highest total; on a tie, the higher loss data score wins.

  2. 2

    Name the team and write day 1

    Sponsor, pillar lead, the controller, the area manager and the other pillar leads who will take the projects.

  3. 3

    Set the baseline and the day-90 targets

    Losses with a cost, projects on plan, top losses with a project, savings confirmed by finance and savings against estimate.

  4. 4

    Run the 13 weeks and update the plan every week

    Move a bar if your area needs it, write the week each activity really finished, and add one actual per KPI each week. Late activities turn red in the Excel version.

  5. 5

    Pass the day-90 gate

    The sponsor and pillar lead check the six gate items with evidence. If one is not met, fix it before any other area starts.

  6. 6

    Plan the expansion waves

    Wave 1 goes to areas with the same cost structure, wave 2 to the next areas by share of conversion cost, and wave 3 to the rest of the plant, so one loss map steers all the pillars.

The 90-day plan

Week by week: from the loss map to savings

The standard plan printed on page 1 and in the Excel version. Days 1 to 30 are weeks 1 to 4, days 31 to 60 weeks 5 to 9 and days 61 to 90 weeks 10 to 13. Move the weeks to fit your area.

  • 1

    Activity
    Choose the model area and form the team (Setup)
    Owner
    Pillar lead
    Deliverable
    Team list; area chosen with the selection table
    Done when
    Team named, sponsor agreed, first meeting held
  • 1 to 3

    Activity
    Collect the costs and the loss data (Data)
    Owner
    Controller
    Deliverable
    Area cost by type; loss records by process and loss type
    Done when
    Each cost and loss source has an owner
  • 2 to 4

    Activity
    Map where the losses happen (Loss map)
    Owner
    Pillar lead
    Deliverable
    Loss map: each loss type against each process step
    Done when
    Every process step checked for every loss type
  • 3 to 5

    Activity
    Separate causal and resultant losses (Loss map)
    Owner
    Model area team
    Deliverable
    Each resultant loss linked to the causal loss that creates it
    Done when
    Every resultant loss traced to a cause
  • 4 to 6

    Activity
    Put a cost on each loss (Costing)
    Owner
    Controller
    Deliverable
    Cost of each loss, using rates agreed with finance
    Done when
    Every loss has a cost and the rates are written down
  • 5 to 7

    Activity
    Rank the losses by cost (Costing)
    Owner
    Pillar lead
    Deliverable
    Pareto of loss cost for the area
    Done when
    Top losses chosen for projects
  • 6 to 8

    Activity
    Match each top loss to a method and a pillar (Projects)
    Owner
    Other pillar leads
    Deliverable
    Method and pillar for each top loss
    Done when
    Each top loss has a pillar owner
  • 7 to 9

    Activity
    Estimate savings and cost for each project (Projects)
    Owner
    Controller
    Deliverable
    Expected saving, cost and payback for each project
    Done when
    Each estimate checked by the controller
  • 8 to 10

    Activity
    Launch the projects (Projects)
    Owner
    Area manager
    Deliverable
    Project list with owners, targets and dates
    Done when
    Projects started on the top losses
  • 10 to 13

    Activity
    Track savings against the estimates (Follow-up)
    Owner
    Controller
    Deliverable
    Monthly savings against estimate for each project
    Done when
    Savings counted the agreed way
  • 11 to 13

    Activity
    Update the loss map with new data (Loss map)
    Owner
    Pillar lead
    Deliverable
    Loss map and Pareto refreshed
    Done when
    Map shows what moved and what is next
  • 13

    Activity
    Day-90 review and decision to expand (Gate)
    Owner
    Sponsor
    Deliverable
    Day-90 gate sheet, KPIs against baseline, lessons
    Done when
    Gate signed by the sponsor and the pillar lead

What's on the gates

The day-90 gate and the wave gate for cost deployment

The day-90 gate decides whether the model area is ready to be copied; the wave gate is checked for each new area before the next wave starts. Both are on page 3 of the PDF and on the Excel version's Day-90 gate and Expansion sheets.

Day-90 gate

All met before the first expansion wave starts

  1. 1Every loss in the area is mapped to the process step where it happens
  2. 2Every resultant loss is traced to its causal loss
  3. 3Every loss has a cost, using rates finance agreed
  4. 4The top losses have a method, a pillar owner and a project
  5. 5The KPI board has 13 weeks of data against the baseline
  6. 6The loss map, rates and lessons are written up so another area can copy them

Wave gate

For each new area, before the next wave starts

  1. 7The area passed the same day-90 gate as the model area
  2. 8Its KPIs are measured against its own baseline, not the model area's
  3. 9The loss map method and cost rates were copied and adapted, and the copy is recorded
  4. 10Coaches for the next wave are named and have run a session with the pillar lead watching
  5. 11The model area was audited again and still holds its standard

A filled-in example

Illustrative, not a benchmark

An example: an automotive parts plant (illustrative, with made-up numbers; the same as page 4 of the PDF and the Excel example sheets). Not a benchmark.

  • Model area choice, loss data, visibility, team willingness and repeatability scored 1 to 3: Machining scored 12, Assembly scored 9 and Heat treatment scored 6. Machining is the largest share of conversion cost with good downtime and scrap data, the controller and area manager asked for the loss map, and the press shop has the same cost structure.
  • Losses with a cost: baseline 20%, day-90 target 100%, week 13 actual 100%, 100% of the gap closed.
  • Projects on plan: baseline 0%, day-90 target 90%, week 13 actual 80%, 89% of the gap closed.
  • Top losses with a project: baseline 0%, day-90 target 100%, week 13 actual 100%, 100% of the gap closed.
  • Savings confirmed by finance: baseline 0 thousand, day-90 target 120 thousand, week 13 actual 84 thousand, 70% of the gap closed.
  • Savings against estimate: baseline 0%, day-90 target 90%, week 13 actual 80%, 89% of the gap closed.

The team passed the day-90 gate in week 13. Wave 1 (months 4 to 6) went to Press shop, assembly, wave 2 (months 7 to 9) to Heat treatment, painting, and wave 3 (months 10 to 12) to Logistics, maintenance workshop, offices, with a model area team member coaching each wave 1 area.

Common mistakes

  • Costing resultant losses twice

    A breakdown that causes scrap and overtime is one cause with several results. Trace each resultant loss to its causal loss and attack the cause.

  • Rates finance never agreed

    Agree the cost rates and how savings are counted with the controller first, or the results will be argued about later.

  • A loss map with no owners

    Each top loss needs a method and a pillar owner, or the map stays a report.

  • Estimates never followed up

    Compare confirmed savings with the estimates every month; it shows which estimates to trust next time.

  • Spreading before the gate

    Copying the map to other areas before the model area's rates and projects hold spreads numbers nobody trusts. Hold the gate, then expand in waves.
