A daily huddle agenda is the running order for a short stand-up at the start of a shift: safety, yesterday's results, today's plan, problems and actions, escalations and a close, in the same order every day, so the team leaves in 15 minutes with actions that have owners. This agenda has six timed blocks: safety (1 minute), yesterday's results by safety, quality, cost, delivery and people (3), today's plan (3), problems and actions (5), escalations (2) and a close (1). Page 2 has a week's action log and a health check the leader ticks each day. The Excel version is a huddle log: start time against plan, length against the target, attendance and the five results as green or red each day, an action log with status and days open, and a summary with the share of green days per pillar.

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

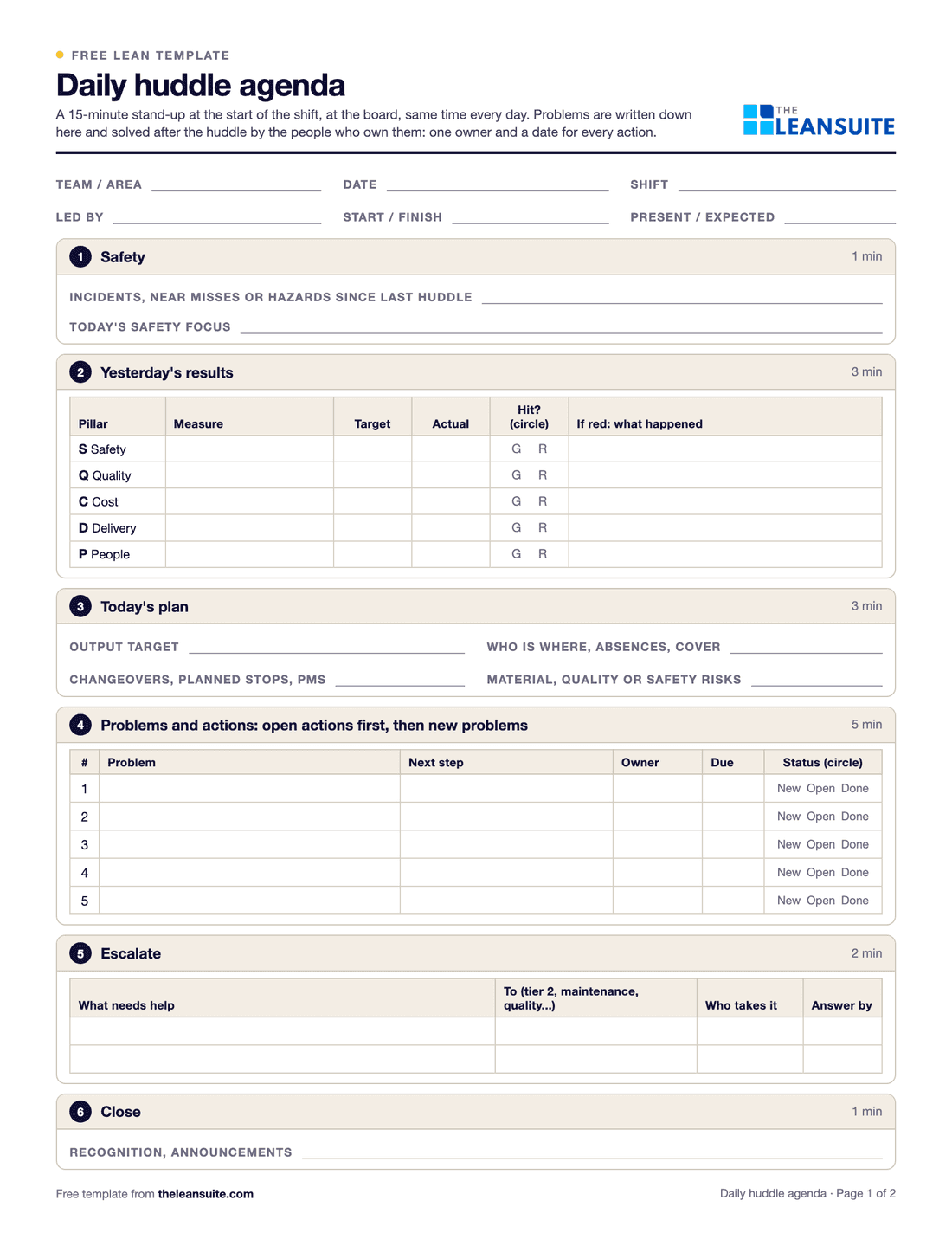

Page 1 of the daily huddle agendaFields for team, date, shift and leader, then six timed blocks: safety, yesterday's results with a row each for safety, quality, cost, delivery and people, today's plan, problems and actions, escalations and close.
Six timed blocksSQCDP resultsToday's planProblems and actionsEscalationsAction logHuddle health check

When to use it

When to use a daily huddle agenda

  • At the start of every shift, for a team of about five to fifteen people.
  • When stand-ups drift past 20 minutes or turn into problem-solving sessions.
  • When starting tiered meetings, as the agenda for the front-line tier.
  • When a new team leader takes over a huddle and needs a structure to follow.

How to fill it in

  1. 1

    Fix the time and place

    Same time, same spot at the board, every day. Start on time even if someone is late.
  2. 2

    Fill in the numbers before the huddle

    Yesterday's results go on the board before people arrive, so the three minutes are spent on the reds, not on writing.
  3. 3

    Run the blocks in order

    Safety first, then results, plan, problems and actions, escalations, close. The times on the sheet add up to 15 minutes.
  4. 4

    Write problems down, solve them later

    A problem raised in the huddle gets one owner and a date. The owner and the people needed solve it after the huddle.
  5. 5

    Escalate what the team cannot fix

    Write who takes it to the next tier and by when, and bring the answer back to the next huddle.
  6. 6

    Check the huddle itself

    Tick the health check daily. Once a week look at it: if huddles run long, problems are being solved in the meeting.

A filled-in example

Illustrative, not a benchmark

An example: an assembly line's day-shift huddle at 06:45, 12 people expected (illustrative).

The example huddle's SQCDP results

  • Safety: on targetOne near miss: a pallet in the aisle
  • Quality: off targetFPY 96.1% vs 98%
  • Cost: on targetOn target
  • Delivery: on target842 of 840
  • People: off targetTwo absences, one covered

Safety, delivery and cost on target; quality off target with first pass yield 96.1 percent against 98; people off target with two absences.

The huddle spends its minutes on the two letters off target. It took 12 minutes, with 11 of 12 people there.
  • Safety: one near miss reported, a pallet left in the aisle by the line end. Focus for today: aisles clear before the 10:00 forklift run.
  • Results: safety, delivery (842 of 840) and cost green; quality red (first pass yield 96.1% against 98%, 14 reworks on one torque step); people red (two absences, one covered by a temp).
  • Plan: 840 units, changeover to model B at 13:00, a 30-minute PM on press 2 at 10:00.
  • Actions: the line lead owns the torque rework, with a 100% check as containment today and the cause by Thursday. Escalated: calibration of the torque tool, to the maintenance supervisor at tier 2, answer by the next huddle.

The huddle took 12 minutes with 11 of 12 people there. The next morning the torque tool was found out of calibration; the quality result was green two days later and the action was closed.

Common mistakes

  • Solving problems in the huddle

    Ten people watching two people solve a problem is the fastest way to a 40-minute huddle. Assign it and move on.

  • Reading out every number

    Greens need no discussion. Spend the time on the reds and what is being done about them.

  • Actions with no owner or date

    'We'll look at it' means nobody will. One name and one date per action.

  • Only the leader talks

    If operators never speak, the huddle is a briefing. Ask the person closest to each red what happened.

Download the template

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

Run this template in LeanSuite

In LeanSuite each huddle runs on a Lean Studio board: the team types the day's KPI values into the board while standing there, creates actions and @mentions people without leaving it, and escalates an item to the next tier with the reply sent back down.

See it in a 45-minute demo

FAQ

Daily huddle agenda: common questions

  1. Safety, yesterday's results against target, today's plan, open problems and new actions, escalations to the next tier, and a short close. Keep the order the same every day.

  2. About 10 to 15 minutes for a front-line team. If it keeps running longer, problems are being solved in the meeting instead of assigned.

  3. A daily huddle is one team's stand-up. Tiered meetings link the huddles: what tier 1 cannot solve goes up to the area leaders at tier 2, and the answers come back down.

  4. Safety, quality, cost, delivery and people: the five areas a team checks its results against each day. Some plants use SQDCM or SQDC for the same idea.

  5. Keep the same order and the same timed blocks every day, stand at the board, and give each problem an owner instead of solving it in the meeting; if it runs past 15 minutes, take the problem offline. The team leader or supervisor usually leads, and rotating parts of it, such as the safety block or the results, gets operators talking and builds the next leaders.

More free templates

All templates
Browse all 278 templates

Can't find the template you need?

Tell us what you're looking for. We'll make it and send it to your inbox, free.

A shift handover sheet, a red tag log, a changeover checklist for one machine: if your team uses it on the floor, ask.
