Environment and energy pillar 90-day model area plan

An environment and energy pillar model area plan is a 90-day plan for proving, on one area of the plant, that waste and energy can be measured, cut at the source and kept down with simple standards, before the method spreads to other areas. The team maps every waste stream and energy user, checks the legal register for the area, rates the environmental aspects, hunts energy losses such as idle running and air leaks, works down the waste hierarchy (refuse, reduce, reuse, recycle) for the top streams, segregates waste at the source and writes the area standards. This template has the 13-week plan as a Gantt chart in three phases with the owner, deliverable and done-when of each activity, a scoring table to choose the model area from loss data, the team, a KPI board, the day-90 gate, and the expansion plan for months 4 to 12 in three waves, with a worked example.

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

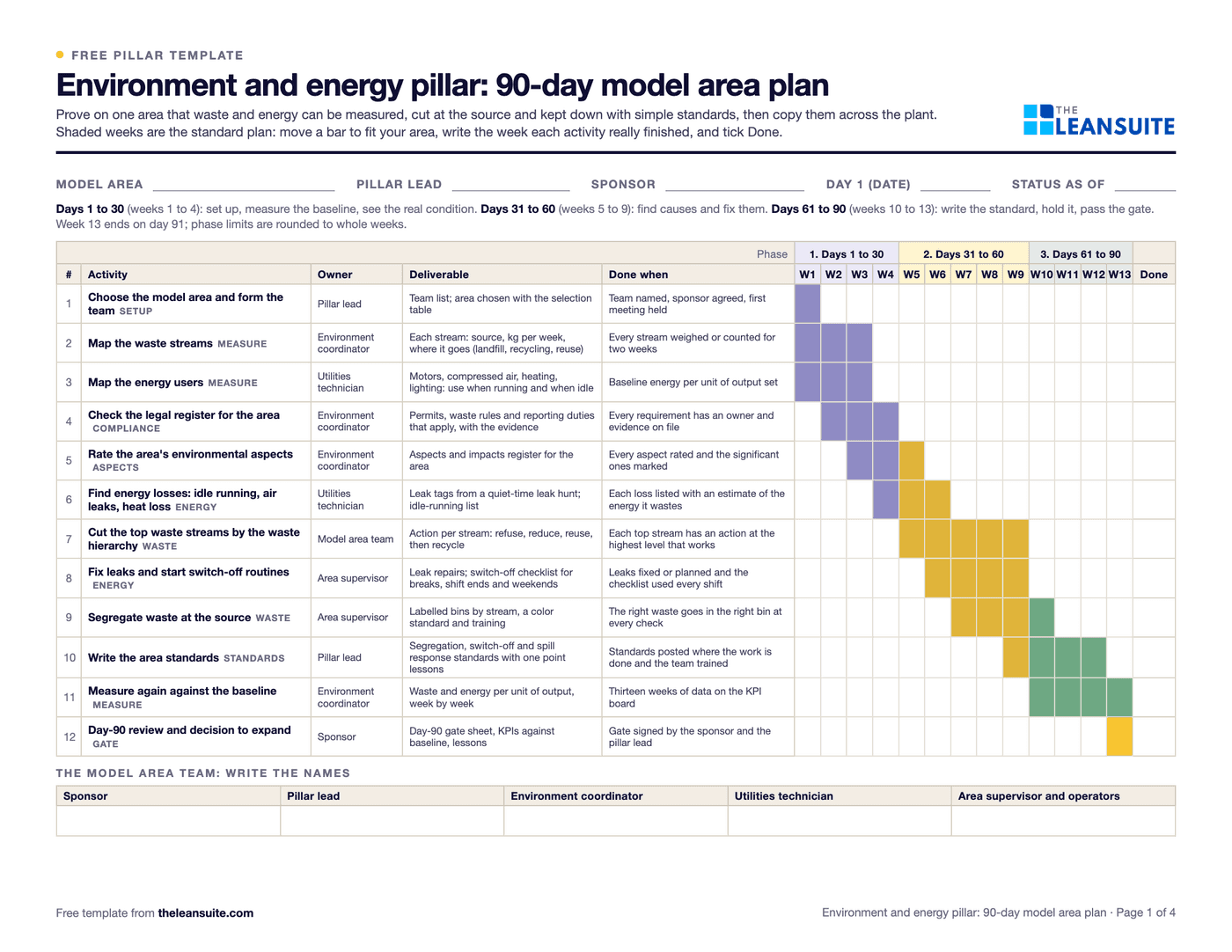

Page 1 of the environment and energy pillar 90-day model area planA 13-week Gantt chart in three phases with the owner, deliverable and done-when of each activity, from the waste and energy maps to the day-90 gate.
13-week Gantt planWaste and energy mapsModel area scoringTeam rolesKPI boardDay-90 gateExpansion wavesWorked example
Filled-in Environment and energy pillar 90-day model area plan: a printing and converting plant
The same sheet filled in with the worked example (page 4 of the PDF, illustrative numbers). Open full size (opens the picture in a new tab)

When to use it

When to use an environment and energy pillar 90-day plan

  • When a plant wants to cut waste and energy with its own people and prove the method in one area before every area is asked to do it.
  • When waste and energy are only known as one figure for the whole site and nobody owns them area by area.
  • When a permit, a customer or a target asks for less waste to landfill or less energy per unit, and the plant needs a plan it can show.
  • When leaders want an environment plan they can review every week: who does what, by when, and what done looks like.

How to fill it in

  1. 1

    Choose the model area from loss data

    Score up to three candidate areas (five in Excel) on loss data, visibility, team willingness and repeatability, from 1 to 3. Loss data here means waste by stream, energy, water and spills by area. Pick the highest total; on a tie, the higher loss data score wins.
  2. 2

    Name the team and write day 1

    Sponsor, pillar lead, the environment coordinator, a utilities technician, and the area supervisor and operators. In Excel, day 1 and the status date set the dates and status of every activity.
  3. 3

    Set the baseline and the day-90 targets

    Waste and energy per unit of output, the share of waste to landfill, air leaks fixed and legal requirements with evidence. Per unit of output keeps a busy week from looking like a failure.
  4. 4

    Run the 13 weeks and update the plan every week

    Move a bar if your area needs it, write the week each activity really finished, and add one actual per KPI each week. Late activities turn red in the Excel version.
  5. 5

    Pass the day-90 gate

    The sponsor and pillar lead check the six gate items with evidence. If one is not met, fix it before any other area starts.
  6. 6

    Plan the expansion waves

    Wave 1 goes to the areas with the same machines, materials or utilities, with the model area team running the first waste and energy walk in each. Each new area runs its own 13 weeks against its own baseline.

The 90-day plan

Week by week: from waste and energy maps to area standards

The standard plan printed on page 1 and in the Excel version. Days 1 to 30 are weeks 1 to 4, days 31 to 60 weeks 5 to 9 and days 61 to 90 weeks 10 to 13. Move the weeks to fit your area.

  • 1

    Activity
    Choose the model area and form the team (Setup)
    Owner
    Pillar lead
    Deliverable
    Team list; area chosen with the selection table
    Done when
    Team named, sponsor agreed, first meeting held
  • 1 to 3

    Activity
    Map the waste streams (Measure)
    Owner
    Environment coordinator
    Deliverable
    Each stream: source, kg per week, where it goes (landfill, recycling, reuse)
    Done when
    Every stream weighed or counted for two weeks
  • 1 to 3

    Activity
    Map the energy users (Measure)
    Owner
    Utilities technician
    Deliverable
    Motors, compressed air, heating, lighting: use when running and when idle
    Done when
    Baseline energy per unit of output set
  • 2 to 4

    Activity
    Check the legal register for the area (Compliance)
    Owner
    Environment coordinator
    Deliverable
    Permits, waste rules and reporting duties that apply, with the evidence
    Done when
    Every requirement has an owner and evidence on file
  • 3 to 5

    Activity
    Rate the area's environmental aspects (Aspects)
    Owner
    Environment coordinator
    Deliverable
    Aspects and impacts register for the area
    Done when
    Every aspect rated and the significant ones marked
  • 4 to 6

    Activity
    Find energy losses: idle running, air leaks, heat loss (Energy)
    Owner
    Utilities technician
    Deliverable
    Leak tags from a quiet-time leak hunt; idle-running list
    Done when
    Each loss listed with an estimate of the energy it wastes
  • 5 to 9

    Activity
    Cut the top waste streams by the waste hierarchy (Waste)
    Owner
    Model area team
    Deliverable
    Action per stream: refuse, reduce, reuse, then recycle
    Done when
    Each top stream has an action at the highest level that works
  • 6 to 9

    Activity
    Fix leaks and start switch-off routines (Energy)
    Owner
    Area supervisor
    Deliverable
    Leak repairs; switch-off checklist for breaks, shift ends and weekends
    Done when
    Leaks fixed or planned and the checklist used every shift
  • 7 to 10

    Activity
    Segregate waste at the source (Waste)
    Owner
    Area supervisor
    Deliverable
    Labeled bins by stream, a color standard and training
    Done when
    The right waste goes in the right bin at every check
  • 9 to 12

    Activity
    Write the area standards (Standards)
    Owner
    Pillar lead
    Deliverable
    Segregation, switch-off and spill response standards with one point lessons
    Done when
    Standards posted where the work is done and the team trained
  • 10 to 13

    Activity
    Measure again against the baseline (Measure)
    Owner
    Environment coordinator
    Deliverable
    Waste and energy per unit of output, week by week
    Done when
    Thirteen weeks of data on the KPI board
  • 13

    Activity
    Day-90 review and decision to expand (Gate)
    Owner
    Sponsor
    Deliverable
    Day-90 gate sheet, KPIs against baseline, lessons
    Done when
    Gate signed by the sponsor and the pillar lead

What's on the gates

The day-90 gate and the wave gate for the environment and energy pillar

The day-90 gate decides whether the model area is ready to be copied; the wave gate is checked for each new area before the next wave starts. Both are on page 3 of the PDF and on the Excel version's Day-90 gate and Expansion sheets.

Day-90 gate

All met before the first expansion wave starts

  1. 1Every waste stream and energy user in the area is measured against the baseline
  2. 2Every legal requirement for the area has an owner and evidence on file
  3. 3The top waste streams have actions at the highest level of the waste hierarchy that works
  4. 4Segregation, switch-off and spill response standards are posted and followed
  5. 5The KPI board has 13 weeks of data against the baseline
  6. 6The maps, standards and lessons are written up so another team can copy them

Wave gate

For each new area, before the next wave starts

  1. 7The area passed the same day-90 gate as the model area
  2. 8Its KPIs are measured against its own baseline, not the model area's
  3. 9The waste and energy standards were copied and adapted, and the copy is recorded
  4. 10Coaches for the next wave are named and have run a session with the pillar lead watching
  5. 11The model area was audited again and still holds its standard

A filled-in example

Illustrative, not a benchmark

An example: a printing and converting plant (illustrative, with made-up numbers; the same as page 4 of the PDF and the Excel example sheets). Not a benchmark.

The example model area at week 13: share of each gap closed

  1. Legal requirements with evidence: 70% to 100%100%
  2. Energy: 210 to 192 kWh per 1,000 units (target 190)90%
  3. Air leaks found and fixed: 0% to 90% (target 100%)90%
  4. Waste to landfill: 55% to 35% (target 30%)80%
  5. Waste: 38 to 31 kg per 1,000 units (target 28)Lowest70%

Legal requirements with evidence: 70% to 100%: 100 percent of the gap closed. Energy: 210 to 192 kWh per 1,000 units (target 190): 90 percent of the gap closed. Air leaks found and fixed: 0% to 90% (target 100%): 90 percent of the gap closed. Waste to landfill: 55% to 35% (target 30%): 80 percent of the gap closed. Waste: 38 to 31 kg per 1,000 units (target 28): 70 percent of the gap closed

Gap closed = (actual − baseline) ÷ (target − baseline). Waste per unit: (31 − 38) ÷ (28 − 38) = 70%.
  • Model area choice, loss data, visibility, team willingness and repeatability scored 1 to 3: Press hall scored 11, Finishing scored 9 and Ink room scored 7. The press hall made the most waste (paper trim and make-ready sheets) and used the most compressed air, sits on the visitor route, and its team asked for better bins.
  • Waste per unit of output: baseline 38 kg per 1,000 units, day-90 target 28 kg per 1,000 units, week 13 actual 31 kg per 1,000 units, 70% of the gap closed.
  • Share of waste to landfill: baseline 55%, day-90 target 30%, week 13 actual 35%, 80% of the gap closed.
  • Energy per unit of output: baseline 210 kWh per 1,000 units, day-90 target 190 kWh per 1,000 units, week 13 actual 192 kWh per 1,000 units, 90% of the gap closed.
  • Air leaks found and fixed: baseline 0%, day-90 target 100%, week 13 actual 90%, 90% of the gap closed.
  • Legal requirements with evidence: baseline 70%, day-90 target 100%, week 13 actual 100%, 100% of the gap closed.

The team passed the day-90 gate in week 13. Wave 1 (months 4 to 6) went to Finishing, cutting room, wave 2 (months 7 to 9) to Ink room, plate making, and wave 3 (months 10 to 12) to Offices, canteen, yard, with a model area team member coaching each wave 1 area.

Common mistakes

  • Starting with recycling

    Recycling is near the bottom of the waste hierarchy. Ask first whether the waste can be refused or reduced at the source, then reused, and recycle what is left.

  • Measuring totals instead of per unit

    Waste and energy rise and fall with output. Divide by units made, or a busy week looks like a failure and a quiet week like a success.

  • Hunting air leaks while the plant is loud

    Leaks are easier to hear and tag when production is stopped. Plan the leak hunt for a break, a weekend or a shutdown.

  • Leaving the legal register to head office

    The area needs to know which permits and waste rules apply to it and where the evidence is kept. Give each requirement an owner.

  • Spreading before the gate

    Copying bins and checklists to every area before the model area holds its numbers spreads habits that have not stuck yet. Hold the gate, then expand in waves.

Download the template

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

Run this template in LeanSuite

In LeanSuite anyone can flag spills, waste, air and water issues as environment tags on the spot, route each one to an owner and close it with an audit trail.

See it in a 45-minute demo

FAQ

Environment and energy pillar 90-day model area plan: common questions

  1. It is one area of the plant where the environment and energy pillar first measures its waste and energy, cuts them at the source and writes the standards, with the people who work there. The model area team then coaches the next areas.

  2. It is the order in which to deal with waste: refuse it (do not create it), reduce it, reuse it, and recycle what is left, with disposal last. The plan works down that order for the area's top waste streams, so recycling is not the first answer.

  3. Because both rise and fall with production. Kilograms or kilowatt-hours per 1,000 units made shows whether the area is really using less, whatever the volume that week.

  4. The permits, consents, waste rules and reporting duties that apply to the area's activities, who owns each one and where the evidence is kept. The plant's environmental lead usually holds the full register; the model area checks its own part of it.

  5. When the model area passes the day-90 gate: every waste stream and energy user measured, every legal requirement owned with evidence, actions on the top streams at the highest level of the hierarchy that works, and the standards followed. Then it spreads in waves, starting with areas that share the same machines or materials.
