Focused improvement 90-day model area plan

A focused improvement model area plan is a 90-day plan for proving, on one line, that the biggest measured losses can be cut by small, focused team projects before the routine spreads to other lines. The team measures OEE and the six big losses, ranks them, charters two or three loss themes, defines each problem at the line, confirms the root causes, trials countermeasures, checks them against the target, standardizes what worked and has finance confirm the savings, while the line team clears the smaller losses with quick kaizen. This template has the 13-week plan as a Gantt chart in three phases with the owner, deliverable and done-when of each activity, a scoring table to choose the model line from loss data, the team, a KPI board, the day-90 gate, and the expansion plan for months 4 to 12 in three waves, with a worked example.

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

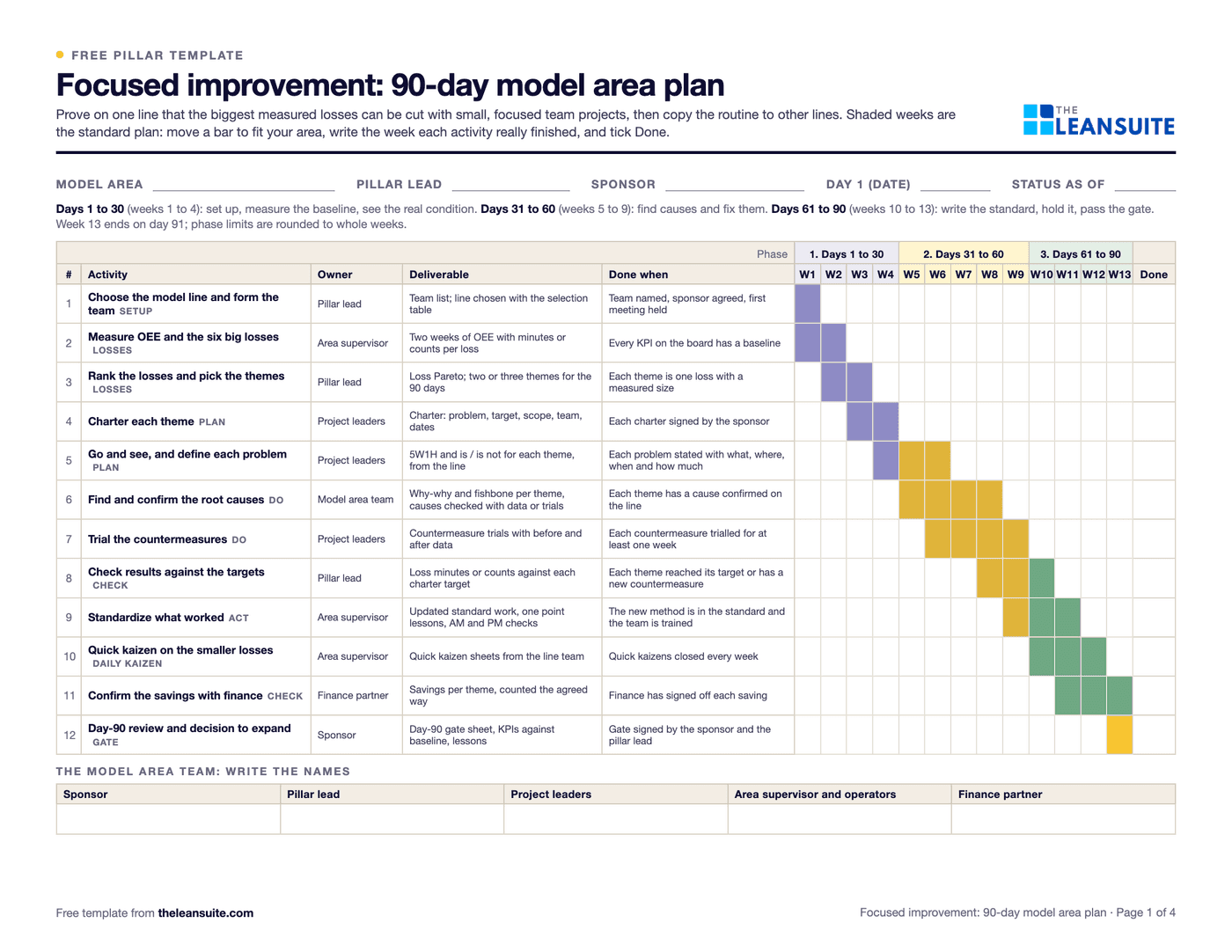

Page 1 of the focused improvement 90-day model area plan: a 13-week Gantt chart in three phases with the owner, deliverable and done-when of each activity, from measuring OEE and the six big losses to the day-90 gate.
13-week Gantt planLoss themes run with PDCAModel area scoringTeam rolesKPI boardDay-90 gateExpansion wavesWorked example

When to use it

When to use a focused improvement 90-day plan

  • When OEE or loss data shows where the losses are, but improvement work is spread thin across many small projects.
  • When a plant wants to prove a loss-based project routine on one line before every line runs it.
  • When a bottleneck line loses output to stops, changeovers or rejects and needs a 90-day plan with clear targets.
  • When leaders want an improvement plan they can review every week: who does what, by when, and what done looks like.

How to fill it in

  1. 1

    Choose the model line from loss data

    Score up to three candidate lines (five in Excel) on loss data, visibility, team willingness and repeatability, from 1 to 3. Loss data here means OEE and the six big losses. Pick the highest total; on a tie, the higher loss data score wins.

  2. 2

    Name the team and write day 1

    Sponsor, pillar lead, a project leader per loss theme, the area supervisor and operators, and a finance partner who agrees how savings are counted.

  3. 3

    Set the baseline and the day-90 targets

    OEE, minutes lost to the top loss, themes closed, quick kaizens and savings confirmed by finance.

  4. 4

    Run the 13 weeks and update the plan every week

    Move a bar if your area needs it, write the week each activity really finished, and add one actual per KPI each week. Late activities turn red in the Excel version.

  5. 5

    Pass the day-90 gate

    The sponsor and pillar lead check the six gate items with evidence. If one is not met, fix it before any other area starts.

  6. 6

    Plan the expansion waves

    Wave 1 goes to the lines with the same equipment or process, with the model line's project leaders running the first loss Pareto in each. Each new line runs its own 13 weeks against its own baseline.

The 90-day plan

Week by week: from the loss Pareto to standardized fixes

The standard plan printed on page 1 and in the Excel version. Days 1 to 30 are weeks 1 to 4, days 31 to 60 weeks 5 to 9 and days 61 to 90 weeks 10 to 13. Move the weeks to fit your line.

  • 1

    Activity
    Choose the model line and form the team (Setup)
    Owner
    Pillar lead
    Deliverable
    Team list; line chosen with the selection table
    Done when
    Team named, sponsor agreed, first meeting held
  • 1 to 2

    Activity
    Measure OEE and the six big losses (Losses)
    Owner
    Area supervisor
    Deliverable
    Two weeks of OEE with minutes or counts per loss
    Done when
    Every KPI on the board has a baseline
  • 2 to 3

    Activity
    Rank the losses and pick the themes (Losses)
    Owner
    Pillar lead
    Deliverable
    Loss Pareto; two or three themes for the 90 days
    Done when
    Each theme is one loss with a measured size
  • 3 to 4

    Activity
    Charter each theme (Plan)
    Owner
    Project leaders
    Deliverable
    Charter: problem, target, scope, team, dates
    Done when
    Each charter signed by the sponsor
  • 4 to 6

    Activity
    Go and see, and define each problem (Plan)
    Owner
    Project leaders
    Deliverable
    5W1H and is / is not for each theme, from the line
    Done when
    Each problem stated with what, where, when and how much
  • 5 to 8

    Activity
    Find and confirm the root causes (Do)
    Owner
    Model area team
    Deliverable
    Why-why and fishbone per theme, causes checked with data or trials
    Done when
    Each theme has a cause confirmed on the line
  • 6 to 9

    Activity
    Trial the countermeasures (Do)
    Owner
    Project leaders
    Deliverable
    Countermeasure trials with before and after data
    Done when
    Each countermeasure trialled for at least one week
  • 8 to 10

    Activity
    Check results against the targets (Check)
    Owner
    Pillar lead
    Deliverable
    Loss minutes or counts against each charter target
    Done when
    Each theme reached its target or has a new countermeasure
  • 9 to 11

    Activity
    Standardize what worked (Act)
    Owner
    Area supervisor
    Deliverable
    Updated standard work, one point lessons, AM and PM checks
    Done when
    The new method is in the standard and the team is trained
  • 10 to 12

    Activity
    Quick kaizen on the smaller losses (Daily kaizen)
    Owner
    Area supervisor
    Deliverable
    Quick kaizen sheets from the line team
    Done when
    Quick kaizens closed every week
  • 11 to 13

    Activity
    Confirm the savings with finance (Check)
    Owner
    Finance partner
    Deliverable
    Savings per theme, counted the agreed way
    Done when
    Finance has signed off each saving
  • 13

    Activity
    Day-90 review and decision to expand (Gate)
    Owner
    Sponsor
    Deliverable
    Day-90 gate sheet, KPIs against baseline, lessons
    Done when
    Gate signed by the sponsor and the pillar lead

What's on the gates

The day-90 gate and the wave gate for focused improvement

The day-90 gate decides whether the model area is ready to be copied; the wave gate is checked for each new area before the next wave starts. Both are on page 3 of the PDF and on the Excel version's Day-90 gate and Expansion sheets.

Day-90 gate

All met before the first expansion wave starts

  1. 1Each theme has a confirmed root cause and a countermeasure checked against its target
  2. 2What worked is in standard work, one point lessons and the AM and PM checks
  3. 3Finance has confirmed the savings, counted the agreed way
  4. 4The line team runs quick kaizen on the smaller losses every week
  5. 5The KPI board has 13 weeks of data against the baseline
  6. 6The charters, analyses and lessons are written up so another team can copy them

Wave gate

For each new area, before the next wave starts

  1. 7The area passed the same day-90 gate as the model area
  2. 8Its KPIs are measured against its own baseline, not the model area's
  3. 9The loss log, charters and the countermeasures that worked were copied and adapted, and the copy is recorded
  4. 10Coaches for the next wave are named and have run a session with the pillar lead watching
  5. 11The model area was audited again and still holds its standard

A filled-in example

Illustrative, not a benchmark

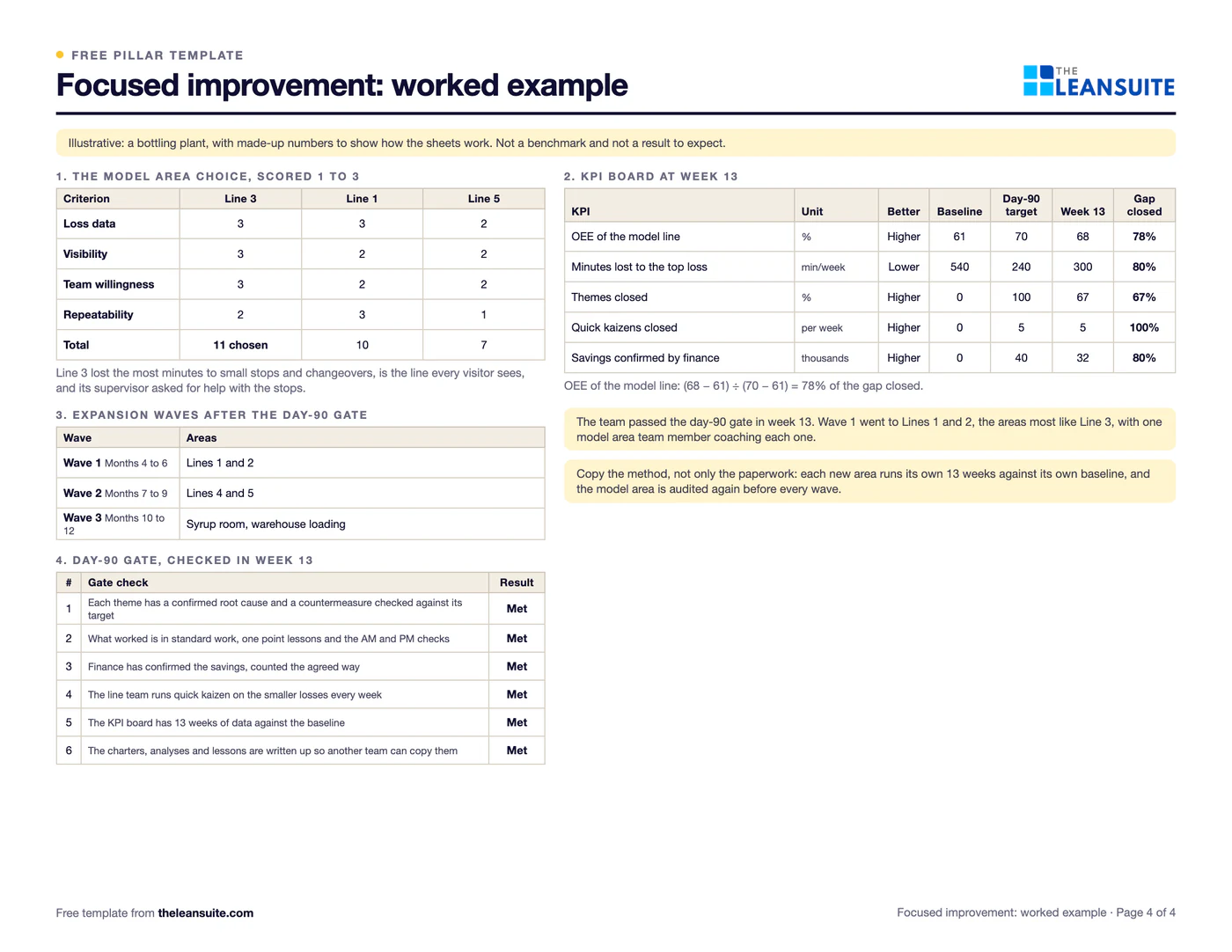

An example: a bottling plant (illustrative, with made-up numbers; the same as page 4 of the PDF and the Excel example sheets). Not a benchmark.

  • Model line choice, loss data, visibility, team willingness and repeatability scored 1 to 3: Line 3 scored 11, Line 1 scored 10 and Line 5 scored 7. Line 3 lost the most minutes to small stops and changeovers, is the line every visitor sees, and its supervisor asked for help with the stops.
  • OEE of the model line: baseline 61%, day-90 target 70%, week 13 actual 68%, 78% of the gap closed.
  • Minutes lost to the top loss: baseline 540 minutes a week, day-90 target 240 minutes a week, week 13 actual 300 minutes a week, 80% of the gap closed.
  • Themes closed: baseline 0%, day-90 target 100%, week 13 actual 67%, 67% of the gap closed.
  • Quick kaizens closed: baseline 0 a week, day-90 target 5 a week, week 13 actual 5 a week, 100% of the gap closed.
  • Savings confirmed by finance: baseline 0 thousand, day-90 target 40 thousand, week 13 actual 32 thousand, 80% of the gap closed.

The team passed the day-90 gate in week 13. Wave 1 (months 4 to 6) went to Lines 1 and 2, wave 2 (months 7 to 9) to Lines 4 and 5, and wave 3 (months 10 to 12) to Syrup room, warehouse loading, with a model area team member coaching each wave 1 area.

Common mistakes

  • Picking themes by opinion

    Choose the themes from the loss Pareto. A theme nobody measured cannot show it closed the gap.

  • Too many themes at once

    Two or three themes the team can finish beat ten that stall. Smaller losses go to quick kaizen.

  • Fixing without confirming the cause

    Check the cause with data or a trial on the line before the countermeasure, or the loss comes back.

  • Counting savings nobody agreed

    Agree with finance how savings are counted before the first project closes, and have them confirm each one.

  • Spreading before the gate

    Copying countermeasures to other lines before they hold on the model line spreads guesses. Hold the gate, then expand in waves.
