People development pillar 90-day model area plan

A people development pillar model area plan is a 90-day plan for proving, in one area, that skill gaps can be found from real losses and closed with structured on-the-job training, before the routine spreads to other areas. The team builds the skills matrix, marks the critical tasks with too few trained people, traces errors and incidents to the skills behind them, trains experienced operators to teach with job instruction, writes job breakdown sheets for the critical tasks, trains and signs people off at the station, adds one point lessons for knowledge gaps and updates the matrix. This template has the 13-week plan as a Gantt chart in three phases with the owner, deliverable and done-when of each activity, a scoring table to choose the model area from loss data, the team, a KPI board, the day-90 gate, and the expansion plan for months 4 to 12 in three waves, with a worked example.

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

Page 1 of the people development pillar 90-day model area plan: a 13-week Gantt chart in three phases with the owner, deliverable and done-when of each activity, from building the skills matrix to the day-90 gate.
13-week Gantt planSkills matrix to trained coverModel area scoringTeam rolesKPI boardDay-90 gateExpansion wavesWorked example

When to use it

When to use a people development 90-day plan

  • When one absence can stop a line because only one person knows a critical task.
  • When errors, defects or incidents keep tracing back to people who were never properly trained.
  • When a plant wants to prove a structured on-the-job training routine in one area before rolling it out.
  • When leaders want a training plan they can review every week: who does what, by when, and what done looks like.

How to fill it in

  1. 1

    Choose the model area from loss data

    Score up to three candidate areas (five in Excel) on loss data, visibility, team willingness and repeatability, from 1 to 3. Loss data here means errors and stops caused by skill gaps, and critical tasks with only one trained person. Pick the highest total; on a tie, the higher loss data score wins.

  2. 2

    Name the team and write day 1

    Sponsor, pillar lead, the area supervisor, the experienced operators who will train, and the training coordinator.

  3. 3

    Set the baseline and the day-90 targets

    Critical tasks with two or more trained people, errors from skill gaps, training plan done, trainers able to teach and breakdown sheets written.

  4. 4

    Run the 13 weeks and update the plan every week

    Move a bar if your area needs it, write the week each activity really finished, and add one actual per KPI each week. Late activities turn red in the Excel version.

  5. 5

    Pass the day-90 gate

    The sponsor and pillar lead check the six gate items with evidence. If one is not met, fix it before any other area starts.

  6. 6

    Plan the expansion waves

    Wave 1 goes to areas with the same jobs or skills, with model area trainers training the new area's first trainers. Each new area runs its own 13 weeks against its own baseline.

The 90-day plan

Week by week: from the skills matrix to trained cover

The standard plan printed on page 1 and in the Excel version. Days 1 to 30 are weeks 1 to 4, days 31 to 60 weeks 5 to 9 and days 61 to 90 weeks 10 to 13. Move the weeks to fit your area.

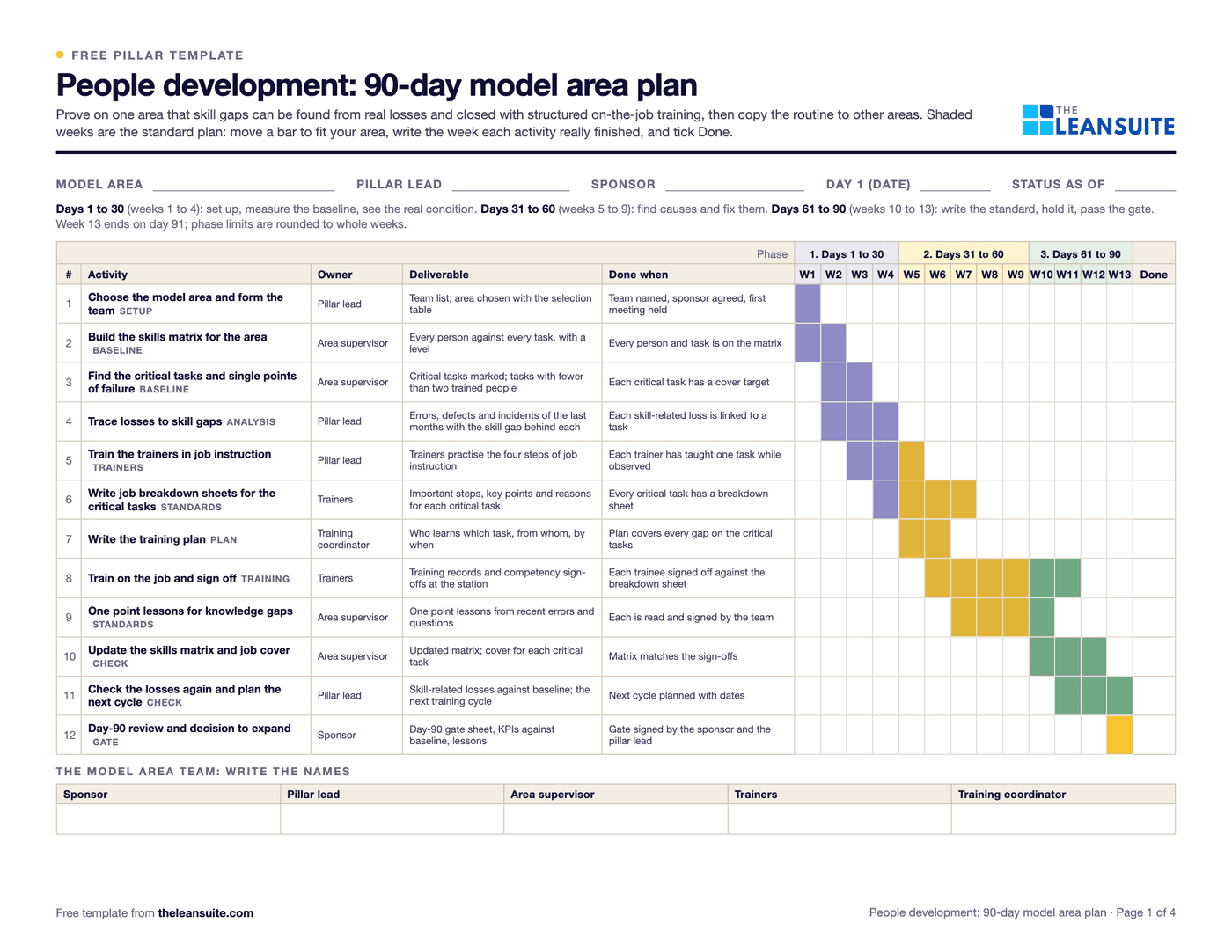

  • 1

    Activity
    Choose the model area and form the team (Setup)
    Owner
    Pillar lead
    Deliverable
    Team list; area chosen with the selection table
    Done when
    Team named, sponsor agreed, first meeting held
  • 1 to 2

    Activity
    Build the skills matrix for the area (Baseline)
    Owner
    Area supervisor
    Deliverable
    Every person against every task, with a level
    Done when
    Every person and task is on the matrix
  • 2 to 3

    Activity
    Find the critical tasks and single points of failure (Baseline)
    Owner
    Area supervisor
    Deliverable
    Critical tasks marked; tasks with fewer than two trained people
    Done when
    Each critical task has a cover target
  • 2 to 4

    Activity
    Trace losses to skill gaps (Analysis)
    Owner
    Pillar lead
    Deliverable
    Errors, defects and incidents of the last months with the skill gap behind each
    Done when
    Each skill-related loss is linked to a task
  • 3 to 5

    Activity
    Train the trainers in job instruction (Trainers)
    Owner
    Pillar lead
    Deliverable
    Trainers practise the four steps of job instruction
    Done when
    Each trainer has taught one task while observed
  • 4 to 7

    Activity
    Write job breakdown sheets for the critical tasks (Standards)
    Owner
    Trainers
    Deliverable
    Important steps, key points and reasons for each critical task
    Done when
    Every critical task has a breakdown sheet
  • 5 to 6

    Activity
    Write the training plan (Plan)
    Owner
    Training coordinator
    Deliverable
    Who learns which task, from whom, by when
    Done when
    Plan covers every gap on the critical tasks
  • 6 to 11

    Activity
    Train on the job and sign off (Training)
    Owner
    Trainers
    Deliverable
    Training records and competency sign-offs at the station
    Done when
    Each trainee signed off against the breakdown sheet
  • 7 to 10

    Activity
    One point lessons for knowledge gaps (Standards)
    Owner
    Area supervisor
    Deliverable
    One point lessons from recent errors and questions
    Done when
    Each is read and signed by the team
  • 10 to 12

    Activity
    Update the skills matrix and job cover (Check)
    Owner
    Area supervisor
    Deliverable
    Updated matrix; cover for each critical task
    Done when
    Matrix matches the sign-offs
  • 11 to 13

    Activity
    Check the losses again and plan the next cycle (Check)
    Owner
    Pillar lead
    Deliverable
    Skill-related losses against baseline; the next training cycle
    Done when
    Next cycle planned with dates
  • 13

    Activity
    Day-90 review and decision to expand (Gate)
    Owner
    Sponsor
    Deliverable
    Day-90 gate sheet, KPIs against baseline, lessons
    Done when
    Gate signed by the sponsor and the pillar lead

What's on the gates

The day-90 gate and the wave gate for people development

The day-90 gate decides whether the model area is ready to be copied; the wave gate is checked for each new area before the next wave starts. Both are on page 3 of the PDF and on the Excel version's Day-90 gate and Expansion sheets.

Day-90 gate

All met before the first expansion wave starts

  1. 1The skills matrix is current and matches the sign-offs
  2. 2Every critical task has a job breakdown sheet
  3. 3The trainers have each taught a task while observed
  4. 4The training plan is on schedule and the next cycle has dates
  5. 5The KPI board has 13 weeks of data against the baseline
  6. 6The training routine and lessons are written up so another team can copy them

Wave gate

For each new area, before the next wave starts

  1. 7The area passed the same day-90 gate as the model area
  2. 8Its KPIs are measured against its own baseline, not the model area's
  3. 9The skills matrix format, breakdown sheets and training routine were copied and adapted, and the copy is recorded
  4. 10Coaches for the next wave are named and have run a session with the pillar lead watching
  5. 11The model area was audited again and still holds its standard

A filled-in example

Illustrative, not a benchmark

An example: an electronics assembly plant (illustrative, with made-up numbers; the same as page 4 of the PDF and the Excel example sheets). Not a benchmark.

  • Model area choice, loss data, visibility, team willingness and repeatability scored 1 to 3: SMT line scored 12, Final test scored 9 and Packing scored 7. The SMT line had the most defects from setup and programming errors, three critical tasks known by one person each, and the same machines run on a second line.
  • Critical tasks with two or more trained people: baseline 40%, day-90 target 100%, week 13 actual 90%, 83% of the gap closed.
  • Errors from skill gaps: baseline 14, day-90 target 4, week 13 actual 6, 80% of the gap closed.
  • Training plan done: baseline 0%, day-90 target 100%, week 13 actual 92%, 92% of the gap closed.
  • Trainers able to teach: baseline 0, day-90 target 4, week 13 actual 4, 100% of the gap closed.
  • Breakdown sheets for critical tasks: baseline 10%, day-90 target 100%, week 13 actual 100%, 100% of the gap closed.

The team passed the day-90 gate in week 13. Wave 1 (months 4 to 6) went to SMT line 2, rework bench, wave 2 (months 7 to 9) to Final test, box build, and wave 3 (months 10 to 12) to Packing, stores, maintenance, with a model area team member coaching each wave 1 area.

Common mistakes

  • Training without a link to losses

    Start from the errors and stops that skill gaps cause, so the training goes where it pays back and the result can be measured.

  • Experts who cannot teach

    Knowing a job and teaching it are different skills. Train the trainers in job instruction before they train others.

  • Signing off on attendance

    Sign a person off when they do the task to the breakdown sheet at the station, not when they sit through a session.

  • A skills matrix nobody updates

    Update the matrix from the sign-offs, or it shows cover the area does not have.

  • Spreading before the gate

    Copying the routine before the model area's critical tasks are covered spreads paperwork. Hold the gate, then expand in waves.

Download the template

Free to use: print it, copy it and edit it for your team. Enter your name and work email once to download.

Run this template in LeanSuite

In LeanSuite the Job Cover Matrix flags jobs with no trained backup; you assign that job's courses, SOPs and OPLs, and a designated trainer's on-the-job sign-off updates the person's level and qualification.

FAQ

People development pillar 90-day model area plan: common questions

More free templates

All templates

Can't find the template you need?

Tell us what you're looking for. We'll make it and send it to your inbox, free.

A shift handover sheet, a red tag log, a changeover checklist for one machine: if your team uses it on the floor, ask.

By sending this form you agree to our Terms of Service and Privacy Policy.
